Dedicated Freight Corridor Timeline 2005–2026: How India Built a Railway Just for Cargo

📅 Updated 8 September 2026PIB, DFCCIL, Ministry of Railways, ReutersInfrastructure & logistics explainer
Advertisement

View as Web Story

In short

India’s Dedicated Freight Corridor timeline 2005–2026: DFCCIL, Eastern DFC, Western DFC, land acquisition, JNPA connectivity and logistics-cost impact.

Latest Story

For decades, India’s freight trains had to share space with passenger trains. A coal rake, a container train, an express service and a local passenger train could all be competing for the same stretch of track — and on India’s busiest routes that competition was severe: the Golden Quadrilateral corridors linking Delhi, Mumbai, Chennai and Kolkata make up only 16% of the rail network but carried more than 58% of its freight, running at 115–150% of line capacity. The Dedicated Freight Corridor timeline is India’s twenty-year answer to that bottleneck: build a high-capacity railway backbone where cargo does not have to keep stepping aside for the next passenger service. On 8 September 2026, the government dedicated the final Western DFC sections linking the network to Jawaharlal Nehru Port — completing the current Eastern and Western DFC network and raising the real question this article is built around: can freight trains actually transform India’s logistics economy?

Can Freight Trains Transform India?

🧠 Quick Answer

The Dedicated Freight Corridor is a high-capacity rail network built mainly for freight trains. India’s current DFC network has two arms: the Eastern DFC, running roughly 1,337 km from Ludhiana to Sonnagar in Bihar, and the Western DFC, running about 1,506 km from Dadri to Jawaharlal Nehru Port. By separating cargo trains from busy passenger routes, the DFC can improve freight speed, reliability, wagon turnaround and port connectivity. The next test is whether this actually translates into lower logistics costs and more freight shifting from road to rail.

⚡ Dedicated Freight Corridor Quick Facts
What it isA railway network built almost entirely for freight trains, separate from passenger lines
Two arms todayEastern DFC (Ludhiana–Sonnagar) and Western DFC (Dadri–JNPT)
Executing bodyDFCCIL, incorporated 30 October 2006 under the Ministry of Railways
ApprovedFebruary 2008, by the Cabinet Committee on Economic Affairs
8 September 2026Final 326 route-km of Western DFC dedicated, cost over ₹20,700 crore
Total project costFrom about ₹28,000 crore (2006 estimate) to roughly ₹1.24 lakh crore
⚡ Quick Answers — AI Overview Ready

Dedicated Freight Corridor: Key Questions

What is the Dedicated Freight Corridor?
A pair of high-capacity railway lines — the Eastern and Western DFC — built specifically for freight trains, so cargo no longer has to share track space and timetable priority with passenger and express services.
Why did it take nearly 20 years to build?
Land acquisition across roughly 11,000 hectares and 77 districts, utility shifting, financing negotiations with two separate lenders, and two lost COVID-19 working seasons stretched a project approved in 2008 well past its original timelines.
What happened on 8 September 2026?
The government dedicated three Western DFC sections — Sanand (North)–Makarpura, New Umbergaon–New Saphale, and New Saphale–JNPA — together 326 route km, built for over ₹20,700 crore, completing the corridor’s direct link to Jawaharlal Nehru Port.
Can the DFC actually lower logistics costs?
It can help: freight speeds on shared tracks average 20–25 km/h against a DFC design target above 60 km/h. But India’s logistics cost, near 14% of GDP against an 8% global benchmark, will only fall if terminals, pricing and road links improve too.
📚 Key Takeaways

What this Dedicated Freight Corridor timeline really shows

  • The DFC’s core purpose is capacity, not comfort. It separates freight traffic from passenger-heavy routes so that neither has to wait on the other.
  • Two arms exist today: the Eastern DFC carries bulk freight like coal and food grain across the north and east; the Western DFC links Delhi-region industry to Jawaharlal Nehru Port.
  • DFCCIL was incorporated in October 2006 as a government special-purpose company, built to execute a mega-project outside routine railway bureaucracy.
  • Two different lenders financed the two corridors: the World Bank backed the Eastern DFC in three loan tranches; Japan’s JICA funded about 77% of the Western DFC through a roughly $5.2 billion soft loan.
  • Land acquisition alone took about four years, covering roughly 11,000 hectares across 77 districts and affecting close to 300,000 project-impacted people.
  • Total project cost rose from about ₹28,000 crore in 2006 to roughly ₹1.24 lakh crore, as engineering, utility-shifting and pandemic delays stacked up.
  • The 8 September 2026 milestone completes the Western DFC’s port connection to JNPA, alongside the already-operational Eastern DFC core between Ludhiana and Sonnagar.
  • This is not the end of India’s freight-corridor building. The Sonnagar–Dankuni stretch, the East–West DFC, and a newly announced Dankuni–Surat corridor are all still in planning or construction.
  • Freight speed has real room to close: about 20–25 km/h on shared tracks today versus a DFC design target above 60 km/h.
  • The real test ahead is economic, not engineering: whether faster, more reliable rail freight actually pulls cargo off India’s roads and lowers the country’s logistics cost from around 14% of GDP toward the roughly 8% global benchmark.

Why Build an Entire Railway Just for Cargo?

Everyday logic: if every train wants the same track, someone has to wait. The DFC gives cargo its own track instead.

Old System — One Shared Track
Passenger train
Freight train
Express train
Freight train
Passenger train
All competing for the same railway capacity, on the same timetable.
DFC Model — Two Separate Networks
Passenger network Passenger trains, express trains, local services
Freight corridor Container trains, coal rakes, cement, automobile and port cargo
Two kinds of traffic, running at different speeds and priorities, on different tracks.
Why this matters: the DFC does not just add tracks. It separates two different kinds of railway traffic that were never a good match on one line — a slow, heavy coal rake and a time-critical passenger express should not have had to queue behind each other in the first place.

Two Freight Backbones: Eastern & Western DFC

Different routes, different cargo — one built for bulk freight across the north and east, the other built to feed India’s busiest container port

Eastern DFC — Ludhiana to Sonnagar
1 Ludhiana / New Sahnewal, Punjab
2 Haryana
3 Uttar Pradesh
4 Bihar
5 New Sonnagar, Bihar
~1,337 km operational core. A further Sonnagar–Dankuni stretch (~540 km, PPP-based) is a separate, still-unfinished project.
Western DFC — Dadri to JNPA/JNPT
1 Dadri, Uttar Pradesh
2 Haryana
3 Rajasthan
4 Gujarat (Vadodara / Ahmedabad region)
5 Mumbai region
6 JNPA / JNPT
~1,506 km, fully linked to the port as of the 8 September 2026 dedication.
JNPA vs JNPT: these refer to the same port. JNPA (Jawaharlal Nehru Port Authority) is the statutory body that runs the port today; JNPT (Jawaharlal Nehru Port Trust) is the older name still used informally in everyday shipping and logistics conversation.

Same Tracks, or a Dedicated Railway?

Toggle between the two models to see what actually changes

🚦 One Corridor, Two Ways to Run It
Choose how freight and passenger trains share the network
Freight and passenger trains run on separate networks. Freight trains run longer, heavier and double-stacked, get priority on their own line, connect directly to ports, and passenger trains gain capacity freed up on the conventional network because freight no longer has to be timetabled around them.
⚠️ Illustrative. Real-world benefit depends on how much freight volume actually shifts onto the DFC and how well ports, terminals and last-mile road links keep up.

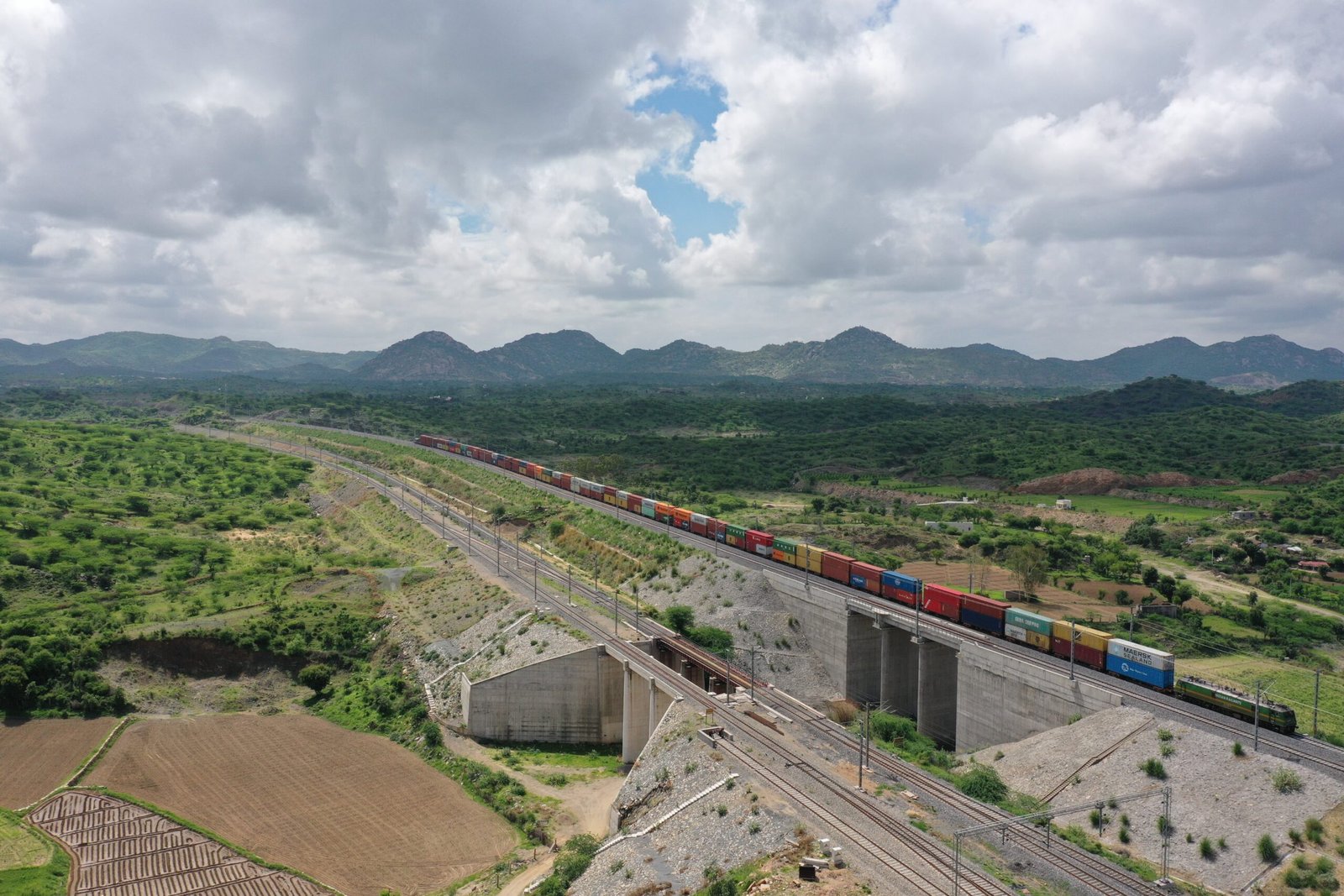

A double-stack container freight train running on an elevated section of India's Western Dedicated Freight Corridor

A double-stack container train on the Western Dedicated Freight Corridor. Credit: DFCCIL / Government Open Data License – India.

A Container’s Journey via the DFC

How the corridor actually fits into a shipment, from factory floor to ship’s deck

  1. Factory: Goods are packed into a standard container at the manufacturing site or a nearby logistics park.
  2. Inland container depot / multi-modal logistics park: The container is trucked to an ICD or MMLC, where it is loaded onto a DFC-bound rake.
  3. DFC train: A double-stack container train runs the corridor — Eastern or Western — at higher priority and higher speed than on a shared conventional line.
  4. Port handover at JNPA: On the Western DFC, the train runs directly into the port complex, handing containers to terminal operators without a road transfer in between.
  5. Ship departure: The container is loaded onto a vessel for export, or the reverse sequence runs for an import container heading inland.
Every step already existed before the DFC. What changes is step 3 and 4: freight moves faster and more predictably, and reaches the port without competing for a passenger-line slot.

Timeline: From a 2005 Feasibility Study to a Fully Linked Port Corridor

Newest developments first. Land acquisition, financing and construction ran in parallel for much of the 2010s.

Before 2005, India’s railway capacity problem was already visible in the numbers. Passenger and freight trains shared most of the network, and on the Golden Quadrilateral routes linking Delhi, Mumbai, Chennai and Kolkata — just 16% of Indian Railways’ total route length — congestion was severe enough that these lines carried more than 58% of the network’s freight at 115–150% of rated line capacity. A heavy, slow-moving coal or steel rake had no good way to avoid delaying, or being delayed by, a scheduled passenger express on the same line. That mismatch is the problem the Dedicated Freight Corridor was built to solve.

8 SEP
2026

Government Dedicates Final Western DFC Sections, Completing the JNPA Link

8 September 2026Vadodara & Gujarat · PIB, DFCCIL

What happened: The government dedicated three Western DFC sections to the nation — Sanand (North)–Makarpura, New Umbergaon–New Saphale, and New Saphale–JNPA — together covering 326 route km and developed at a cost of more than ₹20,700 crore, as part of a wider infrastructure package worth over ₹35,000 crore inaugurated from Vadodara.

Why it matters: This completes the direct rail link between the Western DFC and Jawaharlal Nehru Port. Combined with the already-operational Eastern DFC core between Ludhiana and Sonnagar, the current Eastern and Western DFC network becomes fully operational — though, as later sections of this article explain, that is not the same as saying India’s freight-corridor building is finished.

Interesting fact: JNPA is the statutory authority that runs the port most shippers still call JNPT out of habit — the same facility, two names from two different eras of its history.
326 route km>₹20,700 crore
31 MAR
2026

Final WDFC Stretch Commissioned Between JNPT and Vaitarna

31 March 2026Maharashtra · DFCCIL

What happened: DFCCIL commissioned the last section of track between JNPT and Vaitarna, completing physical construction and safety clearance for train operations across the full roughly 1,506 km Dadri–JNPT Western DFC route.

Why it matters: This is the engineering finish line — freight trains could technically run end to end from that point. The 8 September dedication above is the separate, formal ceremony for the specific port-linking sections.

~1,506 km Dadri–JNPT

Eastern DFC Construction Completed, Corridor Turns Fully Operational

February–April 2024Ludhiana to Sonnagar

What happened: Construction on the Eastern DFC’s operational core was completed in February 2024, and the corridor turned fully operational in April 2024, covering roughly 1,337 km from Ludhiana in Punjab to Sonnagar in Bihar.

Why it matters: Reliable, dedicated freight capacity on this stretch showed up in a real, if narrow, number: a Punjab power plant was able to cut its coal stockpile from about 30 days to 15 days of cover, saving an estimated ₹300–400 crore in inventory costs — a data point, not proof of an economy-wide saving yet.

~1,337 km coreFeb–Apr 2024

Ludhiana–Khurja Section Closes the Last Eastern DFC Gap

August 2023Punjab, Haryana, Uttar Pradesh

What happened: The roughly 400 km Ludhiana–Khurja section — financed under a 2016 World Bank loan (EDFC-3) and built as a single line rather than double track — was commissioned, closing the last major gap before the Eastern DFC’s full completion.

Why it matters: This was the final large construction milestone standing between an “almost complete” corridor and a fully operational one.

Palanpur–Mehsana and Dadri–Khurja Sections Extend Both Corridors

June & October 2022Gujarat / Uttar Pradesh

What happened: The Western DFC’s Palanpur–Mehsana section opened in June 2022, taking the corridor’s operational length to about 720 km. The Eastern DFC’s 46 km Dadri–Khurja branch line opened in October 2022, linking the National Capital Region into the network.

Why it matters: Sections did not open all at once. Each addition brought more of the network into commercial use while construction continued elsewhere.

Rewari–Madar Section Proves Double-Stack Electrified Freight at Scale

January 2021Haryana & Rajasthan · PM Modi inaugurated

What happened: Prime Minister Narendra Modi inaugurated the 306 km Rewari–Madar section of the Western DFC, engineered to run electrified double-stack container trains, with a design speed up to 100 km/h.

Why it matters: Running two stacked containers under live overhead electric wires required extra vertical clearance across the entire corridor — a civil-engineering choice made early that shaped the DFC’s capacity advantage over conventional lines.

306 kmDesign speed up to 100 km/h

New Khurja–New Bhaupur Opens with a New Operations Control Centre

December 2020Uttar Pradesh

What happened: PM Modi inaugurated the 351 km New Khurja–New Bhaupur section of the Eastern DFC, built at a cost of over ₹5,750 crore, alongside a new Operations Control Centre in Prayagraj to manage freight traffic on the corridor.

Why it matters: This was the first large operational stretch of the Eastern DFC, giving northern industrial and agricultural freight a dedicated route that bypassed some of the most congested legacy junctions.

351 km>₹5,750 crore

First Freight Train Trial Run Completes on a 190 km Stretch

August 2018Haryana · Western DFC

What happened: The first trial run of a freight train took place on a completed 190 km segment of the Western DFC.

Why it matters: Ten years after Cabinet approval, this was the moment the project stopped being only drawings, land records and construction contracts, and became a railway a real train could actually run on.

Financing Locks In: World Bank Backs the East, Japan Backs the West

September 2009 onwardTwo lenders, two corridors

What happened: In September 2009 the Union Cabinet approved a Japan International Cooperation Agency (JICA) loan — ultimately around $5.2 billion, funding roughly 77% of the Western DFC’s cost, with conditions tying the financing to Japanese-company participation. The World Bank financed the Eastern DFC in three separate tranches: $975 million in 2011 for the Khurja–Kanpur section, $1.1 billion in 2014 for Kanpur–Mughalsarai, and a further loan in 2016 (EDFC-3) for Ludhiana–Khurja.

Why it matters: Splitting financing this way meant the two corridors were, in effect, built by two different international financing and technical-standards regimes running in parallel — part of why they progressed on different schedules.

JICA: ~$5.2bn, ~77% of WDFCWorld Bank: 3 EDFC loan tranches
2010s

Land Acquisition, Utility Shifting and a Decade of Delay

Roughly 2010–20209 states, 77 districts

What happened: Acquiring roughly 11,000 hectares of land across 77 districts took close to four years and about ₹21,000 crore, and affected close to 300,000 project-impacted people. Relocating power lines, telecom networks, gas pipelines and water and sewer infrastructure added a further ₹10,000–15,000 crore. No-objection certificates from various departments took a year or more each, a 2013 change to India’s land acquisition law paused parts of the process, and the COVID-19 pandemic later cost roughly two working seasons and disrupted supplies of cement, steel and welding oxygen.

Why it matters: This is the single biggest reason a project approved in 2008 did not see its first trial train until 2018. Engineering was rarely the bottleneck; land, utilities and administrative clearances were.

Cabinet Approves Two Corridors: One for the North and East, One for the Ports

February 2008Cabinet Committee on Economic Affairs

What happened: The Cabinet Committee on Economic Affairs approved both the Eastern DFC (Ludhiana toward the east) and the Western DFC (Dadri to Jawaharlal Nehru Port).

Why it matters: India split the plan into two purpose-built arms rather than one single corridor, because the freight problem itself had two different shapes: bulk cargo such as coal and food grain moving through the north and east, and container traffic moving to and from the country’s largest container port.

30 OCT
2006

DFCCIL Is Incorporated to Build and Run the Network

30 October 2006New Delhi

What happened: The Dedicated Freight Corridor Corporation of India Limited was incorporated as a special-purpose company under the Ministry of Railways.

Why it matters: DFCCIL was given the mandate to plan, finance, construct, and eventually operate and maintain the corridors as a dedicated entity, rather than routing a project of this scale through the day-to-day railway administrative structure.

The Idea Takes Shape: Give Cargo Its Own Track

2005Ministry of Railways

What happened: Facing routes running at 115–150% of rated line capacity, railway planners began drawing up freight-only corridors along India’s busiest economic axes, instead of continuing to fit freight movement around an increasingly crowded passenger timetable.

Why it matters: This is the starting point of the entire Dedicated Freight Corridor timeline — the moment the solution shifted from “manage the congestion” to “build a separate railway.”

Can the DFC Actually Cut India’s Logistics Costs?

The engineering is largely done. The economic test is only just starting.

India’s logistics cost is commonly put at around 14% of GDP, against an international benchmark closer to 8%. The DFC is one of the biggest single bets India has made on closing that gap, but the corridor itself does not automatically lower a shipper’s bill. On paper, the potential is real: freight speeds on India’s shared conventional network average around 20–25 km/h, while the DFC’s design target is above 60 km/h. Officials have cited a Mumbai–Delhi transit time falling from about three days to a targeted 48 hours, and NCR-to-Gujarat freight movement falling from four to five days down to about two. The coal-inventory example in the 2024 timeline entry above — a Punjab power plant cutting stockpile days in half — is a real, if narrow, early data point in that direction.

None of that is the same as a guaranteed, economy-wide fall in logistics cost. That depends on how much freight volume actually shifts from road to rail, how quickly ports and inland terminals scale to match the corridor’s capacity, and how first-mile and last-mile road connectivity holds up around each new DFC-linked hub. The Maritime Gateway report on the 8 September 2026 dedication points to exactly this: the metric worth watching next is how fast rail’s share of container evacuation from JNPA actually rises, not the ribbon-cutting itself.

✅ The DFC Can

  • Move freight faster and more reliably on the corridor itself, versus a shared, congested conventional line
  • Run longer, heavier, double-stack container trains under dedicated electrification
  • Connect major industrial belts directly to Jawaharlal Nehru Port without a shared-track bottleneck
  • Free up capacity on conventional lines by moving freight traffic off them

❌ The DFC Cannot (Yet)

  • Guarantee lower shipping prices for exporters and importers by itself
  • Fix first-mile and last-mile road connectivity to factories and warehouses
  • Replace the need for more inland container depots and multi-modal logistics parks
  • Claim to be India’s last freight corridor — several more are still being planned or built

Eastern DFC vs Western DFC, Side by Side

DetailEastern DFCWestern DFC
RouteLudhiana (Punjab) to Sonnagar (Bihar)Dadri (Uttar Pradesh) to JNPA/JNPT (Maharashtra)
Approx. length~1,337 km operational core~1,506 km
States crossedPunjab, Haryana, Uttar Pradesh, BiharUttar Pradesh, Haryana, Rajasthan, Gujarat, Maharashtra
Primary financierWorld Bank (three loan tranches, 2011–2016)Japan International Cooperation Agency (JICA)
Primary cargoCoal, food grain, cement, general bulk freightContainers, double-stack export-import cargo
Fully operational sinceApril 20248 September 2026 (final port-linking sections)
Unfinished extensionSonnagar–Dankuni (~540 km, PPP, in progress)

What It Cost, Year by Year

YearDevelopmentFigure
2006Original project cost estimate~₹28,000 crore
2011World Bank loan, Khurja–Kanpur (EDFC)$975 million
2014World Bank loan, Kanpur–Mughalsarai (EDFC)$1.1 billion
2020New Khurja–New Bhaupur section (EDFC)~₹5,750 crore
2026Three WDFC sections dedicated, 8 September>₹20,700 crore
2026Total infrastructure package inaugurated alongside it>₹35,000 crore
CurrentTotal DFC network cost (Eastern + Western)~₹1.24 lakh crore

Who This Actually Affects

Port operator

JNPA

Gains a direct dedicated rail link, reducing reliance on road transport for container evacuation from India’s busiest container port.

Rail logistics operator

CONCOR & private train operators

Can run longer, double-stack container rakes at higher priority, potentially lowering their per-container haulage cost over time.

Inland infrastructure

ICDs & multi-modal logistics parks

Become the connection points between road-fed factories and DFC-fed rail movement; their capacity is now part of the bottleneck question.

Industry cluster

Exporters & the Bhiwandi logistics cluster

Stand to gain from faster, more predictable transit times to port — if pricing and terminal capacity keep pace with the new rail capacity.

Facts Worth Knowing

  • JNPA (Jawaharlal Nehru Port Authority) and JNPT (Jawaharlal Nehru Port Trust) refer to the same port — JNPA is the current statutory name, JNPT the older name still used informally.
  • DFCCIL was incorporated on 30 October 2006, nearly two years before the Eastern and Western DFC themselves were formally approved by the Cabinet in February 2008.
  • Most of the network is double-tracked and electrified at 25 kV AC, except the Ludhiana–Khurja section of the Eastern DFC, which was built as a single line.
  • Running double-stack containers under live overhead electric wires required extra vertical clearance across the entire Western DFC — an engineering decision baked into the corridor from the start.
  • India is not done building freight corridors: the Sonnagar–Dankuni stretch, the ~2,000 km East–West DFC (Dankuni to Palghar, land acquisition underway), and a newly announced Dankuni–Surat corridor from the Union Budget 2026–27 are all still in planning or construction.
  • The Golden Quadrilateral routes — just 16% of Indian Railways’ route length — carried more than 58% of its freight before the DFC, at up to 150% of rated line capacity.

Explore More Timelines

People Also Ask

Is JNPT the same as JNPA?
Yes. JNPA, the Jawaharlal Nehru Port Authority, is the current statutory body running the port. JNPT, the Jawaharlal Nehru Port Trust, is the older name for the same facility, still used informally across shipping and logistics circles.
Why did the government inaugurate freight corridor sections from Vadodara on 8 September 2026?
The three Western DFC sections dedicated that day — Sanand (North)–Makarpura, New Umbergaon–New Saphale and New Saphale–JNPA — run through Gujarat, and the event was part of a broader infrastructure package inaugurated from Vadodara before the Prime Minister travelled on to Mumbai.
What is the main difference between the Eastern and Western DFC?
The Eastern DFC (Ludhiana to Sonnagar) mainly moves bulk freight such as coal, food grain and cement across northern and eastern India. The Western DFC (Dadri to JNPA/JNPT) is built primarily for container traffic connecting Delhi-region industry to India’s largest container port.
How much of India’s rail freight already moves on the DFC?
DFCCIL and the Ministry of Railways have reported a rising share of freight traffic shifting onto the corridors as sections opened, but a precise, current, verified percentage of total Indian Railways freight tonnage is not something this article states as a specific figure, since public reporting on it varies and updates frequently.
Will the DFC reduce passenger train ticket prices?
Not directly. The DFC’s core benefit for passengers is freed-up capacity on conventional lines, since freight trains move off those routes, which can help punctuality and future capacity for passenger services. It is not designed or expected to change ticket pricing.

Frequently Asked Questions

What is the Dedicated Freight Corridor?
The Dedicated Freight Corridor is a high-capacity railway network built mainly for freight trains, allowing cargo to move separately from busy passenger railway routes instead of sharing track space and timetable priority with them.
When was DFCCIL created?
The Dedicated Freight Corridor Corporation of India Limited was incorporated on 30 October 2006 as a special-purpose company under the Ministry of Railways, tasked with planning, financing, constructing and operating the corridors.
What is the Eastern Dedicated Freight Corridor?
The Eastern DFC is a freight-only railway running roughly 1,337 km from Ludhiana in Punjab to Sonnagar in Bihar, crossing Punjab, Haryana, Uttar Pradesh and Bihar, built mainly to move coal, food grain and other bulk cargo. It became fully operational in April 2024.
What is the Western Dedicated Freight Corridor?
The Western DFC is a freight-only railway running about 1,506 km from Dadri in Uttar Pradesh to Jawaharlal Nehru Port near Mumbai, built mainly for container traffic. Its final port-linking sections were dedicated on 8 September 2026.
When was the DFC completed?
There is no single completion date. The Eastern DFC’s operational core became fully operational in April 2024. The Western DFC’s last stretch was technically commissioned on 31 March 2026, and its final port-linking sections were formally dedicated on 8 September 2026, which is when the current Eastern-plus-Western DFC network became fully operational.
Why did the DFC take nearly 20 years?
The project involved acquiring roughly 11,000 hectares of land across 77 districts, relocating power lines, telecom networks, gas pipelines and water infrastructure, securing financing from two separate international lenders, and absorbing roughly two lost construction seasons during the COVID-19 pandemic.
How does the DFC help Indian Railways?
By moving freight trains onto dedicated tracks, the DFC frees up capacity on conventional railway routes for passenger services, while also allowing freight itself to run faster, in longer and heavier double-stack formations, with fewer overtaking delays.
How does the DFC reduce logistics cost?
It can help by improving freight speed, reliability, wagon turnaround and direct port connectivity. Officials have cited freight speed rising from around 20–25 km/h toward a target above 60 km/h, but the actual reduction in India’s roughly 14%-of-GDP logistics cost depends on terminal capacity, pricing and how much freight shifts from road to rail.
Why is JNPA important for the Western DFC?
JNPA is India’s largest container port. Connecting the Western DFC directly to it means containers can move between the port and inland industrial hubs by dedicated rail rather than congested roads or a shared conventional railway line.
Is India building more freight corridors?
Yes. Beyond the current Eastern and Western DFC, the Sonnagar–Dankuni stretch of the Eastern DFC is still under a separate public-private-partnership process, the roughly 2,000 km East–West DFC (Dankuni to Palghar) has land acquisition underway, and the Union Budget 2026–27 announced a new Dankuni–Surat freight corridor.
What are JNPA and JNPT, and are they different?
They refer to the same port. JNPA, the Jawaharlal Nehru Port Authority, is the current statutory operator. JNPT, the Jawaharlal Nehru Port Trust, was its earlier name and is still commonly used in everyday shipping conversation.
Who financed the Eastern DFC?
The World Bank financed the Eastern DFC across three loan tranches: $975 million in 2011 for the Khurja–Kanpur section, $1.1 billion in 2014 for Kanpur–Mughalsarai, and a further loan approved in 2016 for the Ludhiana–Khurja section.
Who financed the Western DFC?
Japan’s International Cooperation Agency (JICA) financed the Western DFC through a soft loan ultimately worth around $5.2 billion, covering roughly 77% of the corridor’s cost, with the financing tied to participation by Japanese companies.
How much land did the DFC project require?
Roughly 11,000 hectares across 77 districts, acquired over close to four years at a cost of about ₹21,000 crore, affecting close to 300,000 project-impacted people.
What is double-stack container freight?
Double-stack freight trains carry two shipping containers stacked on top of each other on a single wagon, roughly doubling capacity per train. Running them under live 25 kV electric overhead wires, as the Western DFC does, requires extra vertical clearance across the whole corridor.
What was the first operational section of the DFC?
The first freight-train trial run took place in August 2018 on a completed 190 km segment of the Western DFC in Haryana, roughly a decade after the corridors were approved.
What happened on 8 September 2026?
The government dedicated three Western DFC sections — Sanand (North)–Makarpura, New Umbergaon–New Saphale, and New Saphale–JNPA — together covering 326 route km and costing over ₹20,700 crore, completing the corridor’s direct rail link to Jawaharlal Nehru Port.
How much did the DFC network cost in total?
The current Eastern-plus-Western DFC network has cost roughly ₹1.24 lakh crore in total, up from an original 2006 estimate of about ₹28,000 crore, reflecting land, engineering, utility-shifting and pandemic-related cost escalation over nearly two decades.
What is the Rewari–Madar section significant for?
Inaugurated in January 2021, the 306 km Rewari–Madar section was where the Western DFC first proved electrified double-stack container freight at scale, with a design speed up to 100 km/h, rather than just in a trial run.
What is the Sonnagar–Dankuni section, and is it complete?
It is a roughly 540 km planned extension of the Eastern DFC beyond Sonnagar to Dankuni in West Bengal, split into two phases (Dankuni–Gomoh and Gomoh–Sonnagar) and developed on a public-private-partnership basis. It is not yet complete and is separate from the operational Ludhiana–Sonnagar core.
What freight speed does the DFC target?
Officials have cited a design target above 60 km/h for freight on the DFC, compared with an average of around 20–25 km/h for freight trains on India’s shared conventional network.
Does the DFC connect to other Indian ports besides JNPA?
The Western DFC’s primary port link is Jawaharlal Nehru Port (JNPA/JNPT). Feeder lines and future corridor extensions are intended to widen port connectivity over time, but JNPA is the direct terminus discussed in this article.
What is the East–West Dedicated Freight Corridor?
A planned freight corridor of roughly 2,000 km running from Dankuni in West Bengal to Palghar in Maharashtra, approved in the 2016–17 railway budget and currently in the land-acquisition stage. It is separate from, and not yet built like, the current Eastern and Western DFC.
What new freight corridor was announced in the Union Budget 2026–27?
The Union Budget presented on 1 February 2026 announced a new Dedicated Freight Corridor connecting Dankuni in West Bengal to Surat in Gujarat, in addition to the existing Eastern and Western DFC and the previously planned East–West corridor.
Why does India have separate freight and passenger railways at all?
Freight and passenger trains have very different speed and priority needs. On a shared line, a slow, heavy freight train can delay a scheduled passenger express, and vice versa. Separating them lets each type of train run to its own optimal speed and timetable.
What was Golden Quadrilateral congestion, and why does it matter here?
The Golden Quadrilateral rail routes link Delhi, Mumbai, Chennai and Kolkata and made up only 16% of Indian Railways’ route length while carrying over 58% of its freight, at up to 150% of rated line capacity, before the DFC. That congestion is the original problem the DFC was built to relieve.
Is the DFC electrified?
Yes, most of the network runs on 25 kV AC electrification and is double-tracked, with the exception of the Ludhiana–Khurja section of the Eastern DFC, which was built as a single line.
Does the DFC benefit exporters directly?
Potentially, through faster and more predictable transit to Jawaharlal Nehru Port on the Western DFC. Whether that translates into lower shipping costs depends on pricing by rail operators, and on terminal and last-mile road capacity keeping pace with the new rail speed.
What role did COVID-19 play in delaying the DFC?
The pandemic cost the project roughly two working construction seasons and disrupted supplies of cement, steel and welding oxygen, adding further time to a project already slowed by land acquisition and utility-relocation delays.
Who operates freight trains on the DFC?
Indian Railways and its container-freight arm CONCOR, along with private container-train operators licensed to run on the Indian rail network, operate freight services on the DFC; DFCCIL itself builds, owns and maintains the infrastructure.
Is the Dedicated Freight Corridor the same as a bullet train project?
No. The DFC is built exclusively for freight trains and carries no passengers. India’s high-speed passenger rail project (the Mumbai–Ahmedabad bullet train corridor) is an entirely separate initiative with different technology, funding and purpose.

Related AiTimeline Coverage

⚠️ Editorial & Sources Note

Author: The AI Timeline Editorial Team · Last updated: 8 September 2026. This article treats the “current DFC network” as the operational Eastern DFC (Ludhiana–Sonnagar) plus Western DFC (Dadri–JNPA/JNPT), and does not claim India has completed all possible or future freight corridors — the Sonnagar–Dankuni, East–West and Dankuni–Surat corridors remain in progress or planning. Route lengths, dates and financing figures are drawn from DFCCIL, PIB, Ministry of Railways statements and Reuters/wire reporting on the 8 September 2026 dedication, cross-checked against publicly available project documentation. Cost and inventory-saving figures are approximate and cited as such; this is editorial infrastructure coverage, not investment or engineering advice.

Advertisement
Carbon Capture Timeline 1972–2026: CCS, Direct Air Capture & CO₂ Storage Satluj (Punjab ’95) Film Timeline (1995-2026): Development, Censorship, Release, Cast and the Jaswant Singh Khalra Story
Next Article
