James Webb Space Telescope Delays: The Cost of Building Humanity’s Eye on the Universe

📅 Updated 21 October 2026📖 22 milestones🔭 Launched 25 December 2021
Advertisement

View as Web Story

In short

James Webb Space Telescope delays explained: from a 2007 concept to a 2021 launch, with cost baselines, GAO findings and reviews. Updated Oct 2026.

Advertisement

Latest Story

The James Webb Space Telescope delays turned a concept imagined for a 2007 launch into a 25 December 2021 liftoff, with NASA’s lifecycle cost estimate rising from about $1 billion in the concept studies to $9.66 billion in 2018. This timeline runs newest first, separates early estimates, the 2009 baseline, development cost and total lifecycle cost, and shows why independent reviews blamed budgeting and management rather than the technology.

Advertisement
Advertisement

💡 Short Answer

Webb was first imagined for a 2007 launch at about $1 billion. After repeated replans it launched on 25 December 2021 with a NASA lifecycle estimate of $9.66 billion, of which $8.8 billion was development. Independent reviews blamed an understated baseline, thin reserves, integration problems and human errors, not the pandemic or the technology. COVID-19 added about three months in 2020.

⚡ Webb Delays Quick Facts
Concept target2007, ~$1B
2009 baseline$4.964B, Jun 2014
2018 commitment$9.66B, Mar 2021
Development cost$8.8B (2018)
Launched25 Dec 2021
First images11-12 Jul 2022
⚡ Quick Answers — AI Overview Ready

James Webb Space Telescope Delays: Key Questions

Why was Webb delayed?
A baseline set too low with thin reserves, then integration and testing problems, human errors and workmanship issues on the sunshield and propulsion work. The pandemic added about three months in 2020.
How much did Webb cost?
NASA’s 2018 commitment was $8.8 billion for development and $9.66 billion lifecycle, including five years of operations. GAO cited about $9.7 billion in 2020 and 2021.
When was it meant to launch?
About 2007 at the concept stage, June 2013 in the 2005 replan, June 2014 in the 2009 baseline and 30 March 2021 after the 2018 replan. It launched on 25 December 2021.
Did COVID-19 cause the delay?
No. NASA tied about three months of a seven-month slip in 2020 to the pandemic, but the cost growth and delays were already years old.
📚 Key Takeaways

The Webb Cost and Delay Story in Ten Points

  • Concept stage: 1999 studies assumed a 2007 launch and about $1 billion.
  • First formal baseline: $4.964 billion lifecycle and June 2014, set in 2009.
  • Cause: the 2010 panel found budgeting and management problems, not technical performance.
  • Congress: a House committee proposed cancelling Webb in July 2011; instead an $8 billion development cap was set.
  • 2018 replan: March 2021 launch, $8.8 billion development and $9.66 billion lifecycle.
  • GAO, January 2020: costs up about 95% from the 2009 baseline and only a 12% chance of the March 2021 date.
  • COVID-19: added about three months, not the original cause.
  • Launch: 25 December 2021 after a clamp-band incident, a communications issue and weather slips.
  • Science: first images on 11-12 July 2022; four years of operations marked in July 2026.
  • Today: operations budget pressure in 2025 and a quicker Roman launch on 30 August 2026 sharpen the lessons.

James Webb Space Telescope Timeline, Latest First

Each entry is tagged and ends with why it matters. Use the filter to isolate the overrun years.

🎯 Interactive: Filter the Timeline

Concept, overrun, launch or today? Filter the James Webb Space Telescope delays timeline by phase.

–

Advertisement
30 Aug
2026

Roman Space Telescope launches, a contrast case Today

30 Aug 2026, 7:26 am EDTFalcon Heavy from Kennedy Space CenterNASA: ahead of schedule and under cost

NASA’s Nancy Grace Roman Space Telescope launched on a SpaceX Falcon Heavy from Launch Complex 39A on 30 August 2026. NASA described the mission as ahead of schedule and under cost; it had been committed to a launch-readiness date of May 2027. Roman’s own budget baseline was revised after the pandemic, so “under budget” refers to the replanned figure. It is a useful comparison for Webb, though the two missions differ greatly in complexity, with Webb needing a folded mirror and a deployable sunshield.

Why it matters: A flagship telescope can launch early and within its replanned cost, which is the outcome Webb’s reviews said earlier planning would have needed.

Webb marks four years of science Today

ESA release 6 Jul 2026NASA dates the anniversary 12 JulCentaurus A in near- and mid-infrared

ESA and NASA marked four years of Webb science in July 2026 with new images of the galaxy Centaurus A, showing its dust-obscured centre in near- and mid-infrared light. ESA’s accompanying videos covered results from Webb’s fourth year, including an early black hole, Uranus’s auroras and the earliest known supernova. The two agencies’ anniversary dates differ slightly because NASA counts from the 12 July 2022 release of the first science images.

Why it matters: Four years of operations are the strongest argument that the telescope delivered what the long programme promised.

Congress funds NASA science; Webb’s line is unclear Today

P.L. 119-74, Jan 2026NASA about $24.4 bnScience $7.25 bnWebb committee marks: $187 m (House), $208 m (Senate)

Congress passed full-year FY2026 NASA funding in January 2026, keeping the agency near its FY2025 level of about $24.4 billion and well above the administration’s request, with Science at $7.25 billion. The White House request had proposed $140 million for Webb operations. Committee reports in 2025 had marked $187 million (House) and $208 million (Senate); this page could not confirm the final enacted Webb operations figure, because the Congressional Research Service table shows no separate line for FY2026.

Why it matters: Operations budgets, which NASA admitted were “set idealistically low in 2011”, remain the next place where Webb’s costs matter.

Operations squeeze: planning for 20-35% cuts Today

Jan 2025: ~20% cut planningJun 2025 town hall: 25-35% fewer science operationsFY2026 request: $187 m to $140 m

In early 2025 the Space Telescope Science Institute (STScI), which runs Webb’s science operations, said it was asked to plan for roughly a 20% reduction. At a June 2025 town hall, STScI’s Neill Reid described a likely reduction of 25 to 35 percent in science operations, citing inflation, flat budgets and the FY2026 request, and saying that operations estimates made in 2011 included “a certain amount of optimism”. Possible effects listed included lower observing efficiency, slower anomaly response and fewer supported instrument modes.

Why it matters: The cost story continues after launch: cheap operating assumptions made in 2011 now meet inflation.
12 Jul
2022

First images and the start of science operations Launch

11 Jul 2022: Webb’s First Deep Field12 Jul 2022: four more targetsScience operations begin

NASA unveiled Webb’s first full-colour image, a deep field of galaxy cluster SMACS 0723, on 11 July 2022, with four more targets released the next day as science operations began. The images followed commissioning in which mirror segments were aligned and instruments calibrated. The release showed what the delayed telescope could do, but did not alter the earlier cost record.

Why it matters: Scientific success and cost overrun are separate facts, and both are part of Webb’s record.
A dense field of thousands of galaxies, some stretched into arcs by gravitational lensing around the cluster SMACS 0723, against black space with a few bright foreground stars
Webb’s First Deep Field: galaxy cluster SMACS 0723, released 11 July 2022. Image: NASA, ESA, CSA and STScI, public domain, via Wikimedia Commons.

Arrival at L2: the fuel surprise Launch

Station-keeping orbit at L2Designed for 10 years of propellantOfficials: roughly 20 years now

Webb reached its operating orbit around the Sun-Earth Lagrange point L2 in January 2022, after a month-long journey during which its sunshield and mirrors deployed. Because the Ariane 5 launch and the first midcourse correction were so precise, NASA officials said much less propellant was used than budgeted, and project manager Bill Ochs said it was “around 20 years of propellant”. That is an early-2022 projection, not a current fuel measurement.

Why it matters: Part of the extra cost bought margin: a launch that left enough fuel to double Webb’s design life.
25 Dec
2021

Launch: 7:20 a.m. EST, Christmas Day Launch

Ariane 5, KourouTelemetry about 5 min after launchSolar array unfolded about 30 min after launch

Webb launched at 7:20 a.m. EST on 25 December 2021 from Europe’s Spaceport in French Guiana. Telemetry was received about five minutes after liftoff, the rocket released the observatory about 27 minutes after launch and its solar array unfolded about 30 minutes in. Many of the deployments that followed had no repair option, which is why the programme spent years on testing.

Why it matters: About 14 years after the 2007 concept target and seven and a half years after the 2009 baseline.
An Ariane 5 rocket carrying the James Webb Space Telescope on its launch pad at dusk with the ESA and Ariane logos visible on the launch tower
Ariane 5 with Webb on the launch pad at Kourou, 23 December 2021. Photo: Bill Ingalls/NASA, public domain, via Wikimedia Commons.

Clamp band, communications and weather add last-minute slips Launch

9 Nov: clamp band incident, disclosed 22 Nov18 Dec to 22 Dec to 24 DecWeather moves launch to 25 Dec

On 9 November 2021 a clamp band securing Webb to its launch-vehicle adapter released suddenly during processing, sending vibration through the observatory; NASA disclosed it on 22 November. The incident moved launch from 18 December to no earlier than 22 December, then a communications issue between the observatory and the launch vehicle moved it to 24 December. After the Launch Readiness Review on 21 December, adverse weather, with upper-level winds a concern, postponed liftoff to 25 December.

Why it matters: The final slips were days, not years, but they came after a year of testing and shipping.

Final obstacles: Ariane 5 anomalies and shipping Overrun

GAO: $9.7 bn, 39 risks, 207 contingency plansLeft California 26 Sep, arrived Kourou 12 Oct

GAO reported in 2021 that Webb’s estimate was about $9.7 billion, nearly double the 2009 baseline, with launch slipped by over seven years. It noted the project managed 39 risks and had developed 207 contingency plans for launch, commissioning and operations, and that NASA reported in March 2021 that launch-vehicle anomalies were likely to cause another delay. Webb shipped by sea through the Panama Canal and arrived in French Guiana on 12 October 2021.

Why it matters: By the end, the main risks were launch and deployment, the one-shot steps that could not be repaired.
16 Jul
2020

Pandemic: launch moves to 31 October 2021 Overrun

30 Mar 2021 to 31 Oct 2021NASA: about 3 months from pandemic precautionsSlip of about 7 months

In July 2020 NASA moved Webb’s launch from 30 March 2021 to 31 October 2021. It attributed about three months of the slip to social distancing and other coronavirus precautions, with the rest reflecting remaining technical work. The delay came after GAO had already warned that the March 2021 date had only a 12 percent chance of being met.

Why it matters: COVID-19 added to the delay but did not cause the overrun, which began a decade earlier.

GAO: costs up 95%, reserves nearly gone Overrun

Jan 2020 GAO-20-22476% of schedule reserve used by Oct 201912% chance of 30 Mar 2021

GAO’s January 2020 report found costs up about 95 percent since the 2009 baseline, to about $9.7 billion, and launch delayed by more than 6.5 years. It said the project had used about 76 percent of its schedule reserve as of October 2019 and estimated only a 12 percent chance of launching on 30 March 2021. Problems in 2019 with certain spacecraft components ruled out a November 2020 goal, and April 2019 issues with two components used to transmit science data consumed much of the remaining reserve. Keeping the contractor workforce employed longer than planned could add costs.

Why it matters: Reserves exist to absorb surprises; once they were spent, each new problem moved the date.
27 Jun
2018

Replan: March 2021 and $9.66 billion Overrun

Independent Review Board chaired by Tom YoungLaunch 30 Mar 2021$8.8 bn development, $9.66 bn lifecycle

On 27 June 2018 NASA announced the results of its Independent Review Board, chaired by Tom Young, and committed to a launch no earlier than 30 March 2021. It set development cost at $8.8 billion ($8.803 billion in later reporting) and lifecycle cost at $9.66 billion, with the difference reflecting five years of operations. The board found that technical issues, including human errors, had greatly affected the schedule, and NASA cited environmental testing and Northrop Grumman’s work performance on the sunshield and propulsion system. The $8 billion development cap Congress set in 2011 was now exceeded and Congress raised it.

Why it matters: The replan formalised the overrun and set a more credible reserve structure.
Sep 2017-
Mar 2018

Two slips in six months: October 2018 to May 2020 Overrun

Sep 2017: Mar-Jun 2019 window27 Mar 2018: no earlier than May 2020Sunshield integration problems

In September 2017 NASA moved launch from October 2018 to a March-June 2019 window after assessing remaining integration and test work, with Thomas Zurbuchen saying it did not reflect hardware performance concerns. On 27 March 2018 it said the spring 2019 window was no longer possible and moved to no earlier than May 2020. Acting Administrator Robert Lightfoot said the tasks were “taking longer to complete than we expected”; reports tied the slip to integration problems with the sunshield and propulsion work and noted a possible breach of Congress’s $8 billion development cap.

Why it matters: Schedule reserve consumed in 2017 left no room for the sunshield problems that followed.

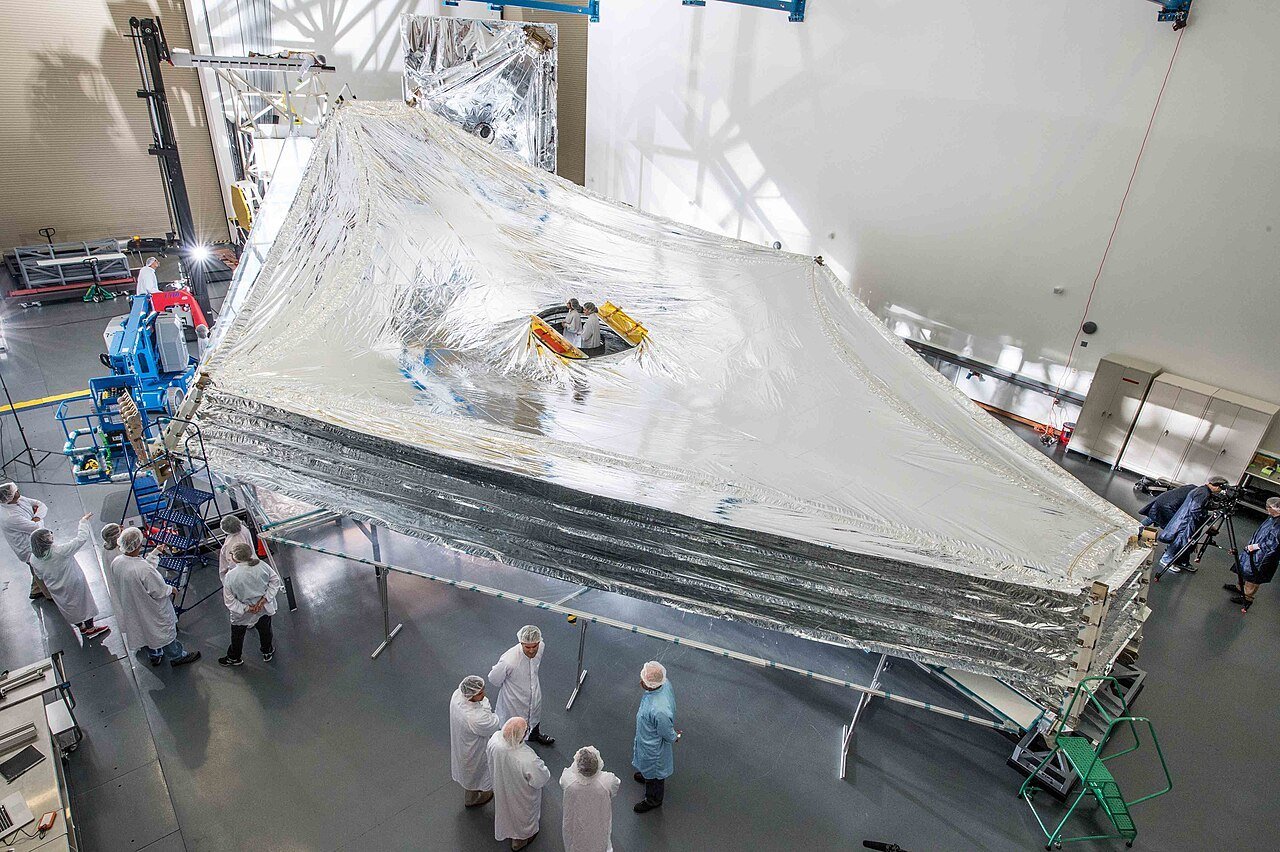

The silver five-layer sunshield of the James Webb Space Telescope spread out in a large cleanroom while technicians in white suits inspect it
Full-scale deployment and tensioning test of Webb’s five-layer sunshield at Northrop Grumman. Photo: Chris Gunn/NASA, CC BY 2.0, via Wikimedia Commons.

Mirror complete, cryogenic testing passed Overrun

2 Nov 2016: mirror reveal at Goddard2017: telescope passes cryo test at JohnsonAug 2017: Hurricane Harvey, no delay

NASA revealed the completed primary mirror to press and officials at Goddard on 2 November 2016, a major milestone for hardware that had been under construction since 2004. In 2017 the optical telescope element passed cryogenic testing at Johnson Space Center, and Webb withstood Hurricane Harvey in late August without a schedule delay according to NASA. Individual components were largely working; the unfinished work was integration of the full observatory.

Why it matters: The mirror, the part many feared would fail, was not the main cause of the delay.

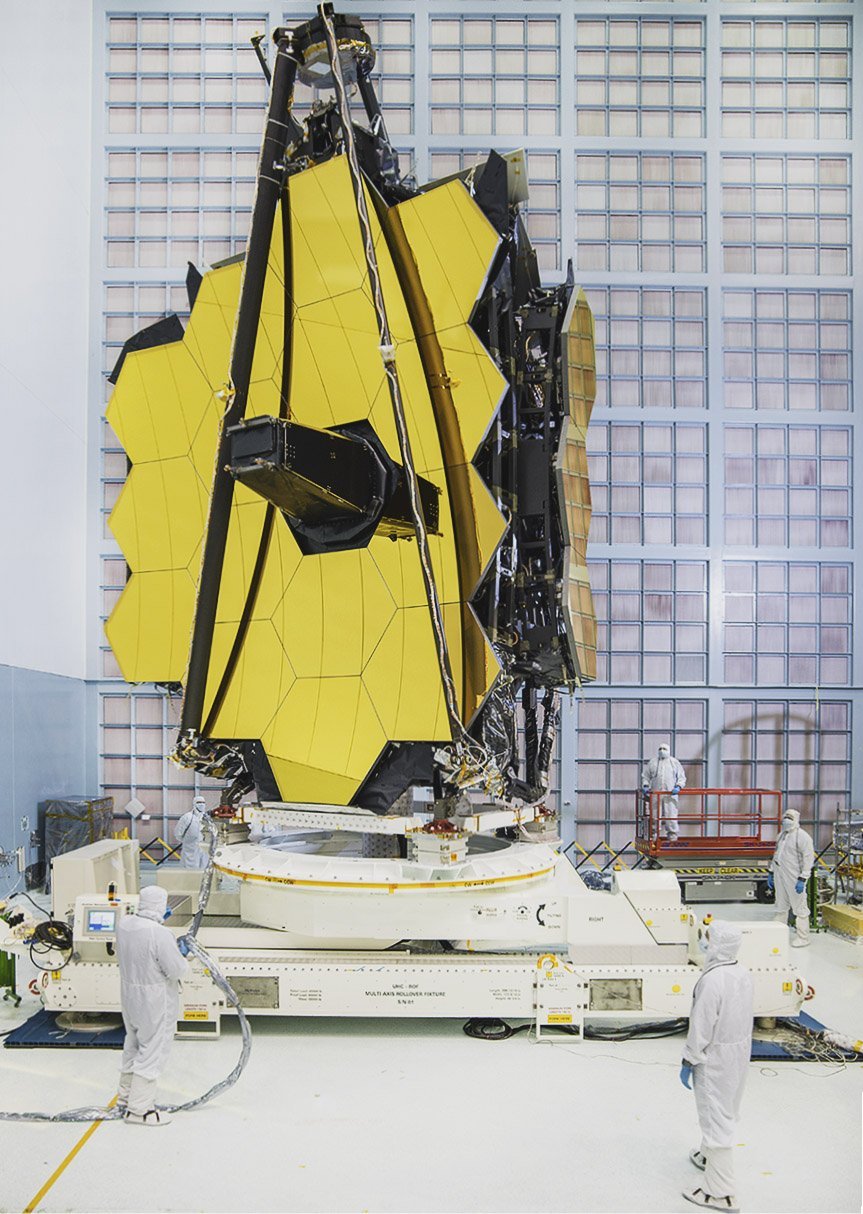

The gold-coated primary mirror of the James Webb Space Telescope in a cleanroom with one wing folded back, with technicians in white suits below
The Webb telescope with one of its two mirror wings folded in the Goddard cleanroom, 2016. Photo: Chris Gunn/NASA, public domain, via Wikimedia Commons.
Officials and journalists seated in front of a glass wall behind which the gold hexagonal mirror segments of the James Webb Space Telescope are visible, with a Webb sign above
NASA reveals the completed Webb primary mirror to press and officials at Goddard, 2 November 2016. Photo: NASA/GSFC/Bill Hrybyk, public domain, via Wikimedia Commons.

Congress sets an $8 billion cap and keeps Webb alive Overrun

Jul 2011: House Appropriations Committee recommends cancellationNov 2011: FY2012 conference agreement$8 bn cap on formulation and development

After the 2010 review, NASA developed a revised plan with a lifecycle cost of about $8.7 billion and a launch date of October 2018, reported as $8.835 billion lifecycle in later congressional summaries. In July 2011 the House Appropriations Committee recommended cancelling the project. Congress instead continued funding in the FY2012 conference agreement of November 2011, subject to a cap of $8 billion on formulation and development costs, which NASA said it could meet by launching in 2018.

Why it matters: The cap applied to development only, which is why $8 billion and $8.7 billion are both correct figures for different things.

Independent panel: budget and management, not technology Overrun

ICRP chaired by John CasaniReserves under 20% in two highest-spend yearsMinimum cost-to-launch: Sept 2015, about $1.4 bn more

The Independent Comprehensive Review Panel, chaired by John Casani of the Jet Propulsion Laboratory, concluded that cost growth and delay were associated with budgeting and program management, not technical performance. It found the baseline accepted at confirmation was not based on a current bottoms-up estimate, did not include known threats and carried reserves that were too low, under 20 percent in the two highest expenditure years against a Goddard standard of 25 percent. NASA management had thought there was a 70 percent probability of launching in June 2014 for nearly $5 billion; the panel said the project “had no chance of meeting either the schedule or the budget profile”.

Why it matters: The review traced the problem to the original budget, years before the sunshield tests.

Formal baseline: $4.964 billion, June 2014 Overrun

$4.381 bn development + $582 m operationsLaunch June 2014Lifecycle rose about $1.5 bn between 2005 and 2008

In FY2009 NASA committed to Webb’s first formal baseline: a lifecycle cost of $4.964 billion, made up of $4.381 billion for formulation and development and $582 million for operations, with launch in June 2014. Before approval management had moved the baseline launch date from June 2013 to June 2014 to add reserves. The Congressional Research Service notes the estimate had already risen about $1.5 billion from the $3.5 billion of early 2005 by the time the baseline was set. GAO later used this baseline as the reference for its measures of cost growth.

Why it matters: Everything after 2009 is measured against this baseline, including GAO’s 95% cost growth.

Replan to $4.5 billion and an independent review Overrun

Jan 2005: $3.5 bn lifecycle2005 replan: $4.5 bn incl. ~$1.0 bn for 10 years of operationsApr 2006: independent review

An early 2005 estimate stood at $3.5 billion lifecycle. The 2005 replan, which included a significant redesign, put it at about $4.5 billion, comprising roughly $3.5 billion for design, development, launch and commissioning and about $1.0 billion for ten years of operations. The project was independently reviewed in April 2006, and NASA designated Webb a development project that year. The 2010 panel later said the reserve problem “was recognized as a problem at the time”.

Why it matters: Cost growth was already visible a decade before launch.

The telescope is renamed for James Webb Concept

Renamed James Webb Space TelescopeTRW/Ball design selected for Phase BNorthrop Grumman acquires TRW

In 2002 NASA renamed the Next Generation Space Telescope after James E. Webb, the NASA administrator during much of the Apollo programme. The same year it selected the TRW/Ball design for Phase B, and Northrop Grumman acquired TRW, becoming the prime contractor. The design set the demanding features that defined later problems: a segmented mirror, infrared instruments and a deployable sunshield.

Why it matters: Webb’s defining features were also its hardest to integrate and test.

Concept studies assume 2007 and about $1 billion Concept

1999: Phase A studies by Lockheed Martin, Ball, TRWPotential launch 20072001 decadal survey: about $1 bn

In 1999 NASA commissioned concept studies from Lockheed Martin, Ball Aerospace and TRW for a potential launch in 2007 on a budget of about $1 billion. The 2001 National Academies decadal survey endorsed the project with a total cost estimate of $1 billion. That figure covered an early concept, not the later flight design, and is the origin of the often-quoted “$1 billion to $10 billion” comparison.

Why it matters: The 2007 date and $1 billion figure were concept-stage targets, not a formal baseline.

An infrared telescope larger than Hubble is recommended Concept

1996: committee led by Alan DresslerMirror larger than 4 m1997: NASA studies with Goddard, TRW, Ball

In 1996 an 18-member committee led by Alan Dressler recommended a space telescope with a mirror larger than four metres to observe in the infrared, a successor to Hubble that could see through dust and capture light from distant objects stretched into the infrared. In 1997 NASA selected Goddard, TRW and Ball Aerospace to refine technical and financial requirements.

Why it matters: The mission began as a scientific ambition; the costs of building it came later.

A workshop at STScI starts the conversation Concept

Next Generation Space Telescope workshopOver 130 attendeesNASA and STScI

In September 1989 the Space Telescope Science Institute and NASA held a Next Generation Space Telescope workshop of more than 130 attendees, an early milestone in the idea that became Webb. Hubble had itself been launched only in 1990.

Why it matters: Webb’s timeline is more than 35 years long, from workshop to fourth anniversary.
Advertisement
Advertisement

The Cost Estimates in One Picture

Webb cost estimates by baseline, US$ billionEarly bars are concept or partial scopes; gold bars are lifecycle or near-lifecycle figures. Not like for like.0246810$1B1999-2001Concept$3.5BJan 2005Early est.$4.5B2005Replan$4.964B2009Baseline$8.7B2011Replan$9.66BJun 2018Replan$9.7B2020-21GAOSources: NASA, GAO-20-224, CRS IF10940, Wikipedia (2005 replan). 2011 figure is NASA’s replan estimate; CRS cites $8.835B.
Estimates roughly doubled between the 2009 baseline and the 2011 replan, then crept up to about $9.7 billion. Scope differs between bars.

The Launch Date That Kept Moving

Planned launch date, by the year each plan was madeDashed line: launch the same year as the plan. The gap above it is the expected wait.200820122016202020002005201020152020Concept: 2007Replan: Jun 2013Baseline: Jun 2014Replan: Oct 2018Sep 2017: spring 2019Mar 2018: May 2020Jun 2018: Mar 2021Jul 2020: Oct 2021Launched 25 Dec 2021
Every re-plan moved the date by more than the time that had passed since the last one.
Plan madeTarget launchWhat changed
19992007Concept studies, about $1B budget
2005 replanJune 2013Baseline date, before the move to 2014 for added reserves
2009 baselineJune 2014First formal baseline; $4.964B lifecycle
Late 2010September 2015 (panel estimate)Casani panel: earliest possible, needing ~$1.4B more
2011 replanOctober 2018Post-review plan; $8B development cap
Sep 2017March-June 2019Integration and test work longer than planned
27 Mar 2018No earlier than May 2020Spring 2019 window lost
27 Jun 201830 March 2021Independent Review Board replan
16 Jul 202031 October 2021Pandemic precautions, ~3 of the ~7 months
Nov-Dec 202118, 22, 24, then 25 DecClamp band, communications issue, weather
Actual25 December 2021, 7:20 am ESTAriane 5 from Kourou

Which Webb Cost Figure Is Which?

Early estimates, the 2009 baseline, development costs and lifecycle costs measure different things.

BaselineFigureWhat it coversSource
1999-2001 concept~$1.0BEarly concept budget endorsed in the 2001 decadal surveyCRS; Wikipedia
Jan 2005$3.5B lifecycleEstimate before the 2005 replanCRS
2005 replan$4.5B lifecycle~$3.5B development, launch, commissioning + ~$1.0B for 10 years of operationsWikipedia
2009 baseline$4.964B lifecycle$4.381B formulation and development + $582M operations; launch Jun 2014CRS
2011 replan~$8.7B lifecycleReplan for Oct 2018 launch; later summaries cite $8.835BNASA; CRS
2011 Congress cap$8.0BFormulation and development onlyCRS
Jun 2018 replan$8.8B development; $9.66B lifecycleLaunch 30 Mar 2021; lifecycle adds five years of operationsNASA
2020-21~$9.7BGAO total; ~95% above the 2009 baselineGAO-20-224; GAO-21-406

Development vs lifecycle. Development covers designing, building, testing and launching the observatory. Lifecycle adds operations and science support. NASA’s $9.66 billion lifecycle figure in 2018 included five years of operations; the $8.8 billion development figure did not.

Why the $1 billion comparison misleads. The $1 billion figure was an early concept budget. Comparing it with $9.7 billion says something true about the growth in ambition and cost, but not how far a formal baseline was missed. The measured overrun against the 2009 baseline is about 95 percent.

Where this page is cautious. Some early figures come from secondary summaries of NASA and congressional material; the table names the source. The enacted FY2026 Webb operations figure could not be confirmed.

Why Did Webb Cost So Much?

An understated baseline. The 2010 panel found the budget accepted at confirmation was not a bottoms-up estimate and did not include known threats.

Thin reserves. Reserves were under 20 percent in the two highest-spend years, and many were allocated to later years when problems hit earlier.

Engineering complexity. A folded mirror, a five-layer sunshield and cryogenic infrared instruments had to unfold and work 1.5 million kilometres away with no servicing.

Integration and workmanship. NASA’s 2018 review board found technical issues including human errors, and cited environmental testing and Northrop Grumman’s work performance on the sunshield and propulsion system.

Time costs money. Specialist teams, contractors and facilities stayed on payroll longer, and GAO noted the contractor workforce was needed longer than planned.

Six Lessons for Future Mega-Projects

1. Build a credible baseline. The 2010 panel found the confirmation budget was not a bottoms-up estimate and left out known threats, so the project was not executable within its budget.

2. Protect reserves. Reserves were under 20 percent in the two highest-spend years against a 25 percent standard, and by October 2019 about 76 percent of schedule reserve had been used.

3. Test the whole system early. Components passed individually, but integration, sunshield work and human errors consumed the schedule, according to NASA’s 2018 board.

4. Treat schedule risk as financial risk. GAO noted that keeping the contractor workforce employed longer than planned could add costs, so each delay was also a spending decision.

5. Compare costs honestly. Concept, development and lifecycle figures use different scopes. Quoting $1 billion against $9.7 billion without saying so overstates the overrun, and ignoring the overrun understates it.

6. Measure success on both axes. Webb launched, deployed and has operated for four years. That success does not erase the cost record, and the cost record does not erase the success.

Was Webb Worth the Cost?

Webb has returned infrared observations of early galaxies, star-forming regions and exoplanet atmospheres, and its science operations began on 12 July 2022. Its propellant may allow about 20 years of operation, double the design assumption.

The cost is also real. Billions of dollars and years of delay affected public budgets and the scheduling of other missions, and in 2025 the operations budget itself came under strain. Both statements can be true: Webb delivered extraordinary capability, and its development exposed weaknesses in cost estimation, risk management and oversight.

The Popular Story vs the Record

Short versions of the Webb story are useful, but several blur the details.

Popular versionWhat the record shows
Webb cost ten times its original budgetThe $1B figure was a concept-stage target; the first formal baseline was $4.964B lifecycle. Scopes differ
Webb was supposed to launch in 20072007 was a 1999 concept target; formal baselines were June 2013 (2005 replan) and June 2014 (2009)
COVID-19 delayed Webb by yearsNASA attributed about three of a seven-month slip in 2020 to the pandemic; delays began in 2008-10
Webb struggled with failing technologyThe 2010 panel found budgeting and management problems, not technical performance, and the 2021 launch succeeded
Congress cancelled then revived the projectA House committee recommended cancellation in July 2011; Congress kept it with an $8B development cap
$8.8B and $9.66B are conflicting figuresThey are development and lifecycle totals for the same 2018 plan

Webb in Numbers

MeasureFigureSource and caveat
Primary mirror6.5 m, 18 gold-coated hexagonal segmentsNASA
Years from 2007 target to launch142007 concept date to 25 Dec 2021
Years from 2009 baseline to launchAbout 7.5Jun 2014 to 25 Dec 2021
Cost growth since 2009 baselineAbout 95%GAO-20-224
Schedule reserve used by Oct 2019About 76%GAO-20-224
GAO odds of launching 30 Mar 202112%GAO, Jan 2020
Risks managed / contingency plans39 / 207GAO-21-406
Lifecycle cost, 2018 commitment$9.66BNASA; five years of operations
Webb operations request, FY2026$140M vs $187M plannedBudget request; enacted figure not confirmed here

Who Shaped the Webb Story

Roles as described in public sources.

Review panel

John Casani and the ICRP

The 2010 Independent Comprehensive Review Panel found the baseline flawed and reserves too low, and set out a minimum cost to launch.

Review board

Tom Young and the IRB

The 2018 Independent Review Board found technical issues, including human errors, greatly affected the schedule and set a March 2021 earliest launch.

Auditor

US Government Accountability Office

Tracked Webb through annual reports, measuring cost growth, schedule reserves and launch probability.

Project

NASA Goddard Space Flight Center

Manages the Webb project and hosted much of its integration and testing.

Prime contractor

Northrop Grumman

Acquired TRW in 2002 and built the sunshield and spacecraft bus; its work performance was cited in NASA’s 2018 review.

Operator

Space Telescope Science Institute

Runs Webb’s science operations, now facing a squeezed operations budget.

Partners

ESA and the Canadian Space Agency

ESA provided the Ariane 5 launch and instruments; CSA supplied the Fine Guidance Sensor and NIRISS.

Legislature

US Congress

Set the $8 billion development cap in 2011 and later raised it.

Advertisement

Explore More Timelines

People Also Ask

Why did the James Webb Space Telescope cost so much?
A baseline set too low with thin reserves, integration and testing problems, human errors and a launch that slipped about seven years past the 2009 plan, with specialist teams kept on payroll for longer.
How much did the James Webb telescope cost in total?
About $9.66 billion lifecycle in NASA’s 2018 commitment, of which $8.8 billion was development; GAO cited about $9.7 billion in 2020 and 2021.
Was the James Webb telescope delayed by COVID?
Partly. NASA attributed about three months of a seven-month slip in 2020 to the pandemic, but delays began years earlier.
When was Webb supposed to launch?
About 2007 at the concept stage, June 2014 in the 2009 baseline and 30 March 2021 after the 2018 replan. It launched on 25 December 2021.
Is the James Webb telescope still working in 2026?
Yes. It marked four years of science operations in July 2026, and its propellant is projected to last around 20 years.

Frequently Asked Questions

Why was the James Webb Space Telescope delayed?
Independent reviews pointed to a baseline that was too low, with too little reserve, plus integration and testing problems, human errors and workmanship issues, notably on the sunshield and propulsion work. NASA’s 2018 review board said technical issues including human errors greatly affected the schedule. The pandemic added about three months in 2020.
When was the James Webb Space Telescope originally supposed to launch?
Concept studies commissioned in 1999 assumed a launch around 2007 on a budget of about $1 billion. The first formal baselines were later: June 2013 in the 2005 replan and June 2014 in the 2009 baseline. Webb launched on 25 December 2021.
When did the James Webb Space Telescope launch?
On 25 December 2021 at 7:20 a.m. EST (12:20 UTC) on an Ariane 5 from Europe’s Spaceport in Kourou, French Guiana. The date had slipped from 18 December after a clamp-band incident and a communications issue, and from 24 December because of weather.
How much did the James Webb Space Telescope cost?
NASA’s 2018 commitment was $8.8 billion for development and $9.66 billion for the lifecycle, which includes five years of operations. GAO put the total at about $9.7 billion in 2020 and 2021. Early figures such as $1 billion or $4.964 billion use different scopes and are not directly comparable.
What is the difference between development cost and lifecycle cost?
Development cost covers design, building, testing and launch of the observatory. Lifecycle cost adds operations and science support, five years in NASA’s $9.66 billion figure. The $8 billion cap Congress set in 2011 applied to formulation and development only.
How much over budget was the James Webb Space Telescope?
Against the 2009 baseline of $4.964 billion lifecycle, GAO said costs had grown about 95% to roughly $9.7 billion. Against the 2011 replan of about $8.7 billion, the growth was about $1 billion. The answer depends on which baseline is used.
Was the James Webb Space Telescope a technical failure?
No. The 2010 Independent Comprehensive Review Panel found that the problems were associated with budgeting and program management, not technical performance, which it called commendable and often excellent. The observatory launched, deployed and has returned science since July 2022.
Did COVID-19 cause the Webb delays?
No. The delays and cost growth predate the pandemic by many years. In July 2020 NASA moved launch from 30 March 2021 to 31 October 2021 and attributed about three months of the roughly seven-month slip to pandemic precautions. The rest reflected technical and schedule issues.
What did the 2010 independent review find?
The panel chaired by John Casani found the baseline accepted in 2008-09 was not based on a current bottoms-up estimate and did not include known threats, and that reserves were too low. It said the project had no chance of meeting its June 2014 date or its budget, and estimated that a September 2015 launch needed about $1.4 billion more.
Did Congress try to cancel the James Webb Space Telescope?
In July 2011 the House Appropriations Committee recommended cancelling it. Congress instead continued funding in November 2011, subject to a cap of $8 billion on formulation and development costs. The cap was later raised after NASA’s 2018 replan.
What happened in the 2018 replan?
On 27 June 2018 NASA announced that an independent review board chaired by Tom Young had found the earliest possible launch was 30 March 2021. NASA set development cost at $8.8 billion and lifecycle cost at $9.66 billion. It cited human errors and work performance problems on the sunshield and propulsion system.
Why did the sunshield cause delays?
The five-layer sunshield had to fold, survive launch and unfold in space without repair. Testing exposed problems, and GAO reported that work such as strengthening the sunshield used schedule reserves faster than planned. Environmental testing and Northrop Grumman’s work performance on the sunshield were cited in 2018.
What was the clamp band incident?
On 9 November 2021, during preparation at Kourou, a clamp band securing Webb to the launch vehicle adapter released suddenly and caused vibration through the observatory. NASA disclosed it on 22 November, and an investigation pushed launch from 18 December.
Did the James Webb Space Telescope launch on Christmas Day?
Yes. After a communications issue moved it to 24 December, adverse weather at the launch site, with upper-level winds a concern, postponed it to 25 December. Launch Readiness Review had been completed on 21 December.
Why do cost figures for Webb differ across sources?
They refer to different baselines and scopes: the early concept budget, development-only totals, lifecycle totals with five years of operations, and totals with a longer operating period. This page labels the scope for each figure. Treat comparisons of $1 billion with $9.7 billion with care.
Is the James Webb Space Telescope worth the cost?
That depends on what is valued. Webb returns infrared observations of early galaxies, star formation and exoplanet atmospheres that Hubble cannot. The overruns also had consequences for public budgets and other missions. A balanced view recognises both the science and the management lessons.
How long will the James Webb Space Telescope last?
Webb was designed with propellant for 10 years. After a precise Ariane 5 launch and midcourse correction, NASA officials said in early 2022 that it might last about 20 years. That is a projection from 2022, not a 2026 measurement.
Is Webb’s operating budget under pressure in 2026?
Yes, reports from 2025 said STScI was told to plan for roughly 20% cuts and later a 25-35% reduction in science operations. The FY2026 request would have cut Webb operations to $140 million from $187 million; Congress enacted FY2026 NASA funding in January 2026, and this page could not confirm the final Webb figure.
Who runs Webb’s science operations?
The Space Telescope Science Institute (STScI) in Baltimore operates Webb for NASA, with NASA Goddard managing the project and Northrop Grumman as prime contractor for the observatory. ESA provided the launch and instruments, and the Canadian Space Agency provided the Fine Guidance Sensor and NIRISS.
How does Webb compare with the Roman Space Telescope?
NASA’s Nancy Grace Roman Space Telescope launched on 30 August 2026, which NASA described as ahead of schedule and under cost. It followed a replan after COVID, so its budget baseline also moved. It is often cited as a contrast, but the missions differ in complexity.
What were Webb’s early cost estimates?
Concept studies in 1999 assumed about $1 billion and a 2007 launch. A January 2005 estimate was $3.5 billion lifecycle, the 2005 replan put it at $4.5 billion including about $1 billion for ten years of operations, and the 2009 baseline was $4.964 billion.
When did Webb release its first images?
On 11 July 2022 NASA unveiled the first full-colour image, Webb’s First Deep Field of galaxy cluster SMACS 0723, with four more targets released on 12 July 2022, when science operations began.
Is this page a complete account of Webb’s costs?
No. It is a dated, sourced timeline. Some early figures come from secondary summaries, and the enacted FY2026 Webb operations figure could not be confirmed. Where sources differ, the page says so.

Related AiTimeline Stories

⚠️ Editorial Note

This page is a dated, sourced record drawn from NASA, the Government Accountability Office, the Congressional Research Service and the 2010 Independent Comprehensive Review Panel report. Cost figures carry the scope of their baseline and should not be compared without it. Several details in the original brief were refined: the 2007 date and $1 billion figure are concept-stage targets, with formal baselines of June 2013 (2005 replan) and June 2014 (2009); the independent review that found a flawed baseline and low reserves was the 2010 Casani panel, so this page does not attribute those findings to a 2006 review; the 2018 replan was preceded by delays announced in September 2017 and March 2018; and the final December 2021 slips included a clamp-band incident and a communications issue before the weather delay. The enacted FY2026 Webb operations figure and the Roman telescope’s detailed cost position could not be confirmed and are described cautiously.

Advertisement
Cuban Missile Crisis Timeline: How Back-Channel Diplomacy Averted War Indian Bad Loans Crisis: How NPAs Rose to 11.2% and Fell to 1.8%
→
Next Article
