← AiTimeline Home

Society · Metro · Delhi NCR · 1969–2026

Delhi Metro: India’s Punctual Urban Lifeline — A Timeline of Growth and Transformation

📅 Last updated: 25 October 2026📖 19 milestones✎ By Nazish Fatima
Advertisement

View as Web Story

In short

Delhi Metro history from the 2002 launch to 416.5 km today: network length by scope, record ridership, 99.95% punctuality and Phase IV and V(A) expansion.

Advertisement

Latest Story

The Delhi Metro history runs from a 1969 traffic study to a network that, as of 25 October 2026, is 374.47 km long on its core lines and 416.5 km once the Noida Aqua Line and Gurugram Rapid Metro are included. The first section, Shahdara to Tis Hazari, opened to the public on 25 December 2002. DMRC recorded 8.19 million passenger journeys on 8 August 2025 and reports 99.95% punctuality for 2026. Two Phase IV sections opened on 8 March 2026, Phase V(A) was approved on 24 December 2025, and the Golden Line is still under construction. Network-length figures vary widely in search results because they differ in date and scope, so this page labels both. For related infrastructure stories, see AiTimeline’s timelines of Indian Railways electrification, FASTag and highway tolls and India’s rising storm risk.

Advertisement

💡 Short Answer

As of 25 October 2026, the core Delhi Metro network is 374.47 km with 271 stations; including the Aqua Line and Rapid Metro, DMRC operates 416.5 km with 303 stations. It began public service on 25 December 2002 between Shahdara and Tis Hazari. Its ridership record is 81,87,674 journeys on 8 August 2025, and DMRC reports 99.95% punctuality for 2026. Phase IV is partly open; Phase V(A) is approved but not built.

⚡ Delhi Metro Quick Facts
Core network374.47 km, 271 stations (Oct 2026)
With Aqua + Rapid416.5 km, 303 stations (Aug 2026)
Opened25 Dec 2002 (inaugurated 24 Dec)
Record day8.19 m journeys, 8 Aug 2025
Punctuality99.95% in 2026 (DMRC)
NextPhase IV remainder, V(A) approved

How Long Is the Delhi Metro? Network Length as of 25 October 2026

Last updated: 25 October 2026. The same system has four commonly quoted lengths. Each is correct for its own scope and date.

What is countedLength and stationsAs ofSource
Core Delhi Metro network (10 lines, no Aqua Line or Rapid Metro)374.47 km, 271 stations (243 if each interchange is counted once)After the 8 Mar 2026 openings; no later opening found as of 25 October 2026Wikipedia, List of Delhi Metro stations
Combined network operated by DMRC (core plus Noida Aqua Line plus Gurugram Rapid Metro)416.5 km, 303 stations, 12 lines, 31 interchange stationsAug 2026 (PTI quoting DMRC)Tribune/PTI; Wikipedia
Aqua Line plus Rapid Metro aloneabout 42 km, 32 stations (the difference between the two rows above)Oct 2026, AiTimeline subtractionDerived, not published as one figure
Core network before March 2026about 353 km, 254 stations (353.31 km on 14 Sep 2025)Sep 2025; a Jan 2026 map gives 352.2 kmThe Metro Rail Guy
Combined network before March 2026394.25 km, 289 stations incl. 29 interchange stations, 12 linesFY 2024-25 annual reportDMRC Annual Report 2024-25
A still-circulating older figure393 km, 288 stations, 12 linesQuoted by Business Today on 25 Jul 2026Business Today

Bar chart of Delhi Metro network length: about 353 km for the core network before 8 March 2026, 374.47 km for the core network after, 394.25 km including the Aqua Line and Rapid Metro before March 2026 and 416.5 km including them in August 2026.
Chart: four Delhi Metro network lengths, 353 km, 374.47 km, 394.25 km and 416.5 km, and what each includes. Chart by AiTimeline from Wikipedia, PTI, DMRC and The Metro Rail Guy.

Why the numbers conflict. The 8 March 2026 openings added about 22 km in one day, which is the gap between 394.25 km and 416.5 km (the combined figure) and between about 353 km and 374.47 km (the core). Older pages and AI summaries keep repeating the pre-March numbers. A July 2026 business feature still quoted 393 km and 288 stations. When quoting a length, give the scope (core or combined), the date and whether it counts only open sections. AiTimeline could not open DMRC’s own network page, so the core figure rests on Wikipedia and the combined figure on a PTI report quoting DMRC and DMRC’s annual report.

⚡ Quick Answers — AI Overview Ready

Delhi Metro: Key Questions

How long is the Delhi Metro?
As of October 2026, 374.47 km and 271 stations for the core network, or about 416.5 km and 303 stations including the Noida Aqua Line and Gurugram Rapid Metro, which DMRC also operates.
When did the Delhi Metro start?
The Prime Minister inaugurated it on 24 December 2002 and public service began on 25 December 2002 on the Red Line between Shahdara and Tis Hazari, about 8.3 km according to the Tribune.
What is the Delhi Metro ridership record?
81,87,674 passenger journeys, about 8.19 million, on 8 August 2025, the eve of Raksha Bandhan. Journeys count trips, not different people.
Is the Delhi Metro really punctual?
DMRC reports 99.95% punctuality for 2026 so far, counting a train as late only if it is more than 59 seconds behind schedule. It is an operator figure, not an independent audit.
📚 Key Takeaways

Delhi Metro History in Ten Points

  • Start: inaugurated on 24 December 2002, open to the public on 25 December.
  • Core network: 374.47 km and 271 stations after the 8 March 2026 openings.
  • Combined network: 416.5 km and 303 stations including the Aqua Line and Rapid Metro.
  • Old figures: 394.25 km (DMRC annual report) and about 353 km were right before March 2026.
  • Record: 8.19 million journeys on 8 August 2025.
  • Punctuality: 99.95% in 2026 by DMRC’s measure, a 59-second threshold.
  • Phase IV: about 24.25 km open; the Golden Line has no opening date.
  • Phase V(A): 16.076 km approved on 24 December 2025, not open.
  • Phase V(B): 97.158 km proposed and awaiting Union approval.
  • Corrections: 25 December 2017 was a Magenta Line opening; the Airport Express opened in 2011.
Advertisement

Delhi Metro History Timeline, Latest First

Each entry is tagged and ends with why it matters. Approvals and proposals are marked Planned, not as network.

Advertisement
9 Aug
2026

DMRC reports 99.95% punctuality and a 416.5 km network Service

9 Aug 2026OperationsReported by PTI

PTI, citing DMRC, reported punctuality of 99.95% for 2026 so far, with a train counted as late only if it arrives more than 59 seconds behind schedule. The same report gave the network as 416.5 km with 303 stations on 12 lines and 31 interchange stations, and average daily ridership of about 64.06 lakh journeys (Tribune/PTI).

The 416.5 km figure includes the Noida Aqua Line and Gurugram Rapid Metro, which DMRC operates. The core Delhi Metro network is 374.47 km. See the length table above.

Why it matters: The punctuality number is DMRC’s own, and its late-train threshold is strict (59 seconds).
3 May
2026

Delhi approves Phase V(B): seven more corridors proposed Planned

3 May 2026PlanningAwaiting Union approval

According to Wikipedia’s summary, the Government of Delhi approved seven Phase V(B) corridors totalling 97.158 km and 65 stations at an estimated ₹48,204 crore and sent the proposal to the Union Government (Wikipedia). A July 2026 Business Today feature put the combined Phase IV, V(A) and V(B) plan at about 217 km, 123 stations and 16 corridors (Business Today).

A state approval is not a Union approval, and neither is a construction start.

Why it matters: Phase V(B) is a proposal. Do not count it as network under construction.
8 Mar
2026

Two Phase IV sections open, taking the core network to 374.47 km Network

8 Mar 2026Magenta and Pink linesPhase IV

Two stretches opened on 8 March 2026: Deepali Chowk to Majlis Park on the Magenta Line (9.92 km, seven stations) and Majlis Park to Maujpur Babarpur on the Pink Line (12.3 km) (Indian Infrastructure). All India Radio counted eight elevated stations on the Pink section and said it takes that line to about 71.56 km (AIR); the Indian Infrastructure list names ten, because it includes Majlis Park, which was already open.

The same event was billed to include foundation stones for three Phase V(A) corridors; AiTimeline found no post-event report confirming it. After these openings, Wikipedia lists the core network at 374.47 km and 271 stations (Wikipedia).

Why it matters: The core network grew by about 22 km in one day, which is why pre-March figures such as 352 km are now out of date.
Bar chart of Delhi Metro network length: about 353 km for the core network before 8 March 2026, 374.47 km for the core network after, 394.25 km including the Aqua Line and Rapid Metro before March 2026 and 416.5 km including them in August 2026.
Chart: four Delhi Metro network lengths, 353 km, 374.47 km, 394.25 km and 416.5 km, and what each includes. Chart by AiTimeline from Wikipedia, PTI, DMRC and The Metro Rail Guy.
24 Dec
2025

Cabinet approves Phase V(A): three corridors, 16.076 km Planned

24 Dec 2025Union Cabinet₹12,014.91 crore

The Union Cabinet approved R.K. Ashram Marg to Indraprastha (9.913 km, with a Central Vista link to the Kartavya Bhawans), Aerocity to IGI Airport Terminal 1 (2.263 km) and Tughlakabad to Kalindi Kunj (3.9 km): 16.076 km at ₹12,014.91 crore (IANS). The report did not give a Phase V(A) completion year. It gave December 2026 only as the target for the separate Phase IV priority corridors.

Approval is a planning milestone. The corridors are not open.

Why it matters: Phase V(A) extends the Magenta and Golden lines, including a second airport terminal link.
24 Dec
2025

The first train, TS#01, marks 23 years Origins

24 Dec 2025Rolling stockPer DMRC

DMRC marked 23 years since the 24 December 2002 inauguration and said the original train, TS#01, is still in service. DMRC says it began with four coaches, went to six in 2014 and to eight in 2023, and has run about 2.9 million km and carried over 60 million passengers (DMRC release). AiTimeline could not open that page, so these figures are as relayed in the source material, not independently checked.

Why it matters: Lengthening trains added capacity without a new line, provided platforms and signalling could take them.

About 2.35 billion journeys in a year Service

Calendar year 2025RidershipJourneys, not people

Wikipedia, citing DMRC data, gives about 235 crore (2.35 billion) passenger journeys in 2025 and an average of roughly 64.6 lakh a day (Wikipedia). A journey is a trip, so someone commuting both ways counts twice. The 2026 average reported by PTI is about 64.06 lakh.

Why it matters: Daily demand is steady near 6.4 million journeys, with festival peaks well above that.
8 Aug
2025

Record day: 81,87,674 passenger journeys Service

8 Aug 2025Ridership recordEve of Raksha Bandhan

DMRC recorded 81,87,674 passenger journeys (about 8.19 million) across all lines on 8 August 2025, its highest single day, a day before Raksha Bandhan. It ran 92 additional trips that day and scheduled 455 extra on 9 August, and social media showed packed platforms on the Yellow, Blue and Violet lines (IANS). The Corporation’s own 2024–25 annual report also calls it “unprecedented” (DMRC annual report), and the 2026 Tribune/PTI report still treats it as the record.

Why it matters: A record is a stress test: the same day showed both the system’s reach and its crowding.

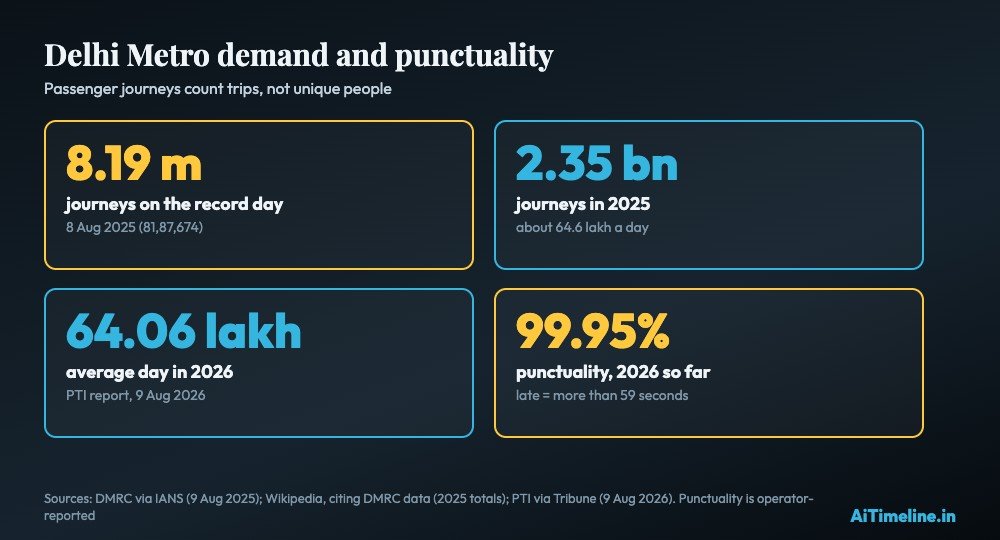

Four tiles: 8.19 million journeys on the 8 August 2025 record day, 2.35 billion journeys in 2025, an average of 64.06 lakh journeys a day in 2026 and 99.95 per cent punctuality in 2026 so far.
Chart: Delhi Metro record day, 2025 journeys, 2026 daily average and punctuality. Chart by AiTimeline from DMRC via IANS, Wikipedia and PTI.
14 Oct
2024

Line 4 reported carbon neutral Service

14 Oct 2024 reportYamuna Bank to VaishaliSustainability

The Tribune reported on 14 October 2024 that DMRC’s Line 4, Yamuna Bank to Vaishali in Ghaziabad, had received a carbon-neutral certification (Tribune). The report did not name the certifier or standard, so treat it as a DMRC claim. The benefit of any metro depends on the electricity it uses and on how many car journeys it replaces.

Why it matters: Certification does not by itself measure how much road traffic the line removes.
5 Jan
2025

Phase IV opens its first section: Janakpuri West to Krishna Park Extension Network

5 Jan 2025Magenta Line2.03 km

The first Phase IV section, Janakpuri West to Krishna Park Extension (2.03 km) on the Magenta Line, was inaugurated on 5 January 2025 (Metro Rail Guy; Wikipedia). Phase IV was finalised by the Delhi Government in December 2018 and construction began on 30 December 2019, with 2026 the expected completion year on Wikipedia’s page.

Why it matters: Only a short slice of Phase IV was open for over a year, so late-2026 targets deserve caution.
17 Sep
2023

Airport Express extends to Yashobhoomi Dwarka Sector 25 Network

17 Sep 2023Airport ExpressNetwork

The Airport Express line was extended from Dwarka Sector 21 to Yashobhoomi Dwarka Sector 25 on 17 September 2023 (Wikipedia). The line first opened as New Delhi to Dwarka Sector 21 on 23 February 2011.

Why it matters: The airport rail link now reaches a convention-centre complex as well as the terminals.
18 Sep
2021

Phase III is completed Network

18 Sep 2021Grey Line162.375 km, 111 stations

Phase III, which began in 2011 and totals 162.375 km and 111 stations, ended with the Grey Line extension to Dhansa Bus Stand on 18 September 2021 (Wikipedia). The Pink Line began driverless operation on 25 November 2021 and the Magenta Line on 28 December 2021. PTI says about 29% of the network now runs with unattended train operation.

Why it matters: Phase III is the largest phase so far, and it added the ring and cross-city lines.
25 Dec
2017

The Magenta Line opens Kalkaji Mandir to Botanical Garden Network

25 Dec 2017Magenta LinePhase III

On 25 December 2017 the Magenta Line section from Kalkaji Mandir to Botanical Garden opened, linking south Delhi with Noida (Wikipedia). The Pink Line followed: its first listed section, Majlis Park to Durgabai Deshmukh South Campus, opened on 14 March 2018. A source brief called the 2017 opening a Pink Line milestone, but the record shows it was the Magenta Line. The brief’s 12.64 km length comes from DMRC’s 2017–18 annual report, which AiTimeline did not open.

Why it matters: Phase III turned a set of radial lines into a network with orbital options.

Phase II is completed: 123.30 km, 86 stations Network

23 Feb to 27 Aug 2011Airport Express and Phase II completion

Phase II stations opened between 4 June 2008 and 27 August 2011, adding 123.30 km and 86 stations. The Airport Express opened from New Delhi to Dwarka Sector 21 on 23 February 2011 and was extended to Dhaula Kuan and Delhi Aerocity on 15 August 2011 (Wikipedia).

Why it matters: The airport link arrived after the 2010 Games, not before.

The Commonwealth Games deadline, and what was not ready Network

3–14 Oct 2010Context

Delhi hosted the Commonwealth Games in October 2010, and Phase II work ran against that deadline. The Airport Express was not open during the Games: its first section opened on 23 February 2011 and its Aerocity extension in August 2011 (Wikipedia). A brief that places the airport link in the 2010 expansion needs that correction. AiTimeline did not find a verified list of which Phase II sections opened specifically for the Games.

Why it matters: Events can set deadlines, but dates still have to be checked against opening records.

Phase I is finished: 64.75 km, 59 stations Network

25 Dec 2002 to 11 Nov 2006Phase I

Phase I stations opened from 25 December 2002 to 11 November 2006, giving 64.75 km and 59 stations (Wikipedia). The underground Yellow Line section opened on 20 December 2004. In 2002 the Tribune expected a 63 km Phase I by 2005; it was completed about a year later than that (Tribune, 25 Dec 2002).

Why it matters: Phase I proved the model, even though it ran later than first projected.

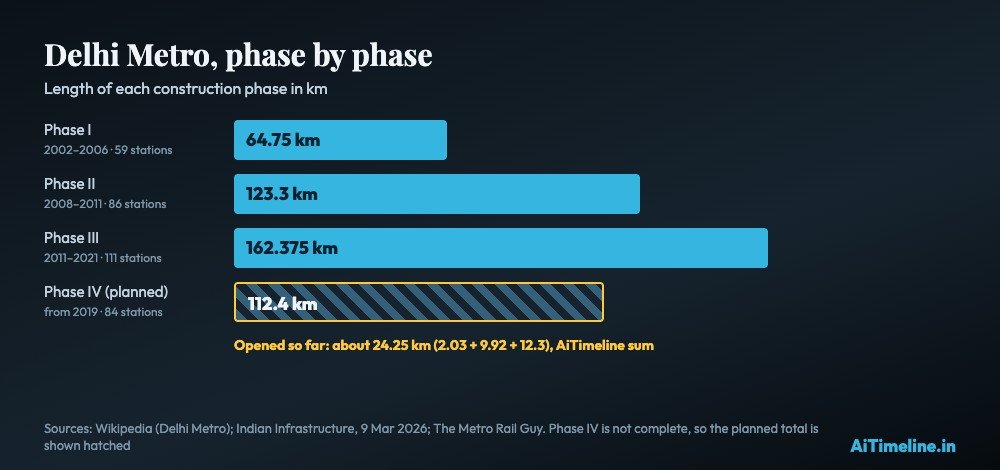

Bar chart of Delhi Metro phases: Phase I 64.75 km, Phase II 123.3 km, Phase III 162.375 km and Phase IV 112.4 km planned, of which about 24.25 km has opened.
Chart: length of Delhi Metro Phases I to IV in kilometres. Chart by AiTimeline from Wikipedia and Indian Infrastructure.
24–25 Dec
2002

Delhi Metro opens: Shahdara to Tis Hazari Origins

24 Dec 2002 inauguration25 Dec public serviceabout 8.3 km

Prime Minister Atal Bihari Vajpayee inaugurated the Metro on Tuesday, 24 December 2002 and rode from Kashmere Gate to Seelampur before flagging the train on toward Shahdara. Public service began on 25 December. The Tribune gave the opening stretch as 8.3 km; other reports say 8.2 or 8.4 km, so treat “about 8 km” as safe (Tribune, 25 Dec 2002). Japan financed 56% of the project through a soft loan of up to ₹2,090 crore.

Why it matters: Dates differ by a day depending on whether a source counts the inauguration or the first public ride.
1 Oct
1998

Construction of Phase I begins Origins

1 Oct 1998Construction

Construction began on 1 October 1998. In 1997 Japan had granted official development assistance loans to finance the first phase (Wikipedia). Building through dense neighbourhoods meant moving utilities, closing roads and coordinating many agencies.

Why it matters: Four years separated the first spade from the first passenger.
3 May
1995

DMRC is set up Origins

3 May 1995Institution

The Government of India and the Government of Delhi set up the Delhi Metro Rail Corporation on 3 May 1995, with E. Sreedharan as managing director (Wikipedia). It is a joint venture of the two governments on an equal footing. The Corporation’s own site was not readable to AiTimeline, so the date rests on Wikipedia.

Why it matters: A dedicated corporation concentrated planning, procurement and operation in one body.

From a traffic study to a mass-transit proposal Origins

1969 and 1984Planning

Wikipedia traces the idea of mass rapid transit for Delhi to a 1969 traffic and travel study. In 1984 the Urban Arts Commission proposed a multi-modal system with three underground mass rapid transit corridors, plus better suburban rail and roads (Wikipedia). The opening in 2002 was the end of a long planning process, not a single decision.

Why it matters: Metro projects take decades from study to ticket; Phase V is on the same slow clock.
Advertisement

Why Is the Delhi Metro Known for Punctuality?

What DMRC reports, and what that does and does not show.

PTI, quoting DMRC in August 2026, reported 99.95% punctuality for 2026 so far, with a train counted as late if it arrives more than 59 seconds behind schedule. Punctuality was reported at 98.27% in 2003 and 99.64% in 2005 and has stayed near 99.9% since. DMRC also cites a mean distance between failures of 2.72 million car-km, a minimum headway of 2 minutes 18 seconds on busy corridors (down from 7 minutes) and unattended train operation on about 29% of the network (Tribune/PTI).

Those are operator figures. Definitions matter: a 59-second threshold, the measurement period and whether partial disruptions count all change the result. AiTimeline found no independent audit in the sources reviewed. A high headline number is consistent with a well-run system and does not mean individual journeys are never delayed by equipment failures, crowding, security incidents or weather.

Four tiles: 8.19 million journeys on the 8 August 2025 record day, 2.35 billion journeys in 2025, an average of 64.06 lakh journeys a day in 2026 and 99.95 per cent punctuality in 2026 so far.
Chart: Delhi Metro record day, 2025 journeys, 2026 daily average and punctuality. Chart by AiTimeline from DMRC via IANS, Wikipedia and PTI.

Delhi Metro Phase by Phase

Length, stations and status of each phase as of 25 October 2026.

PhaseLengthStationsYearsStatus
Phase I64.75 km5925 Dec 2002 to 11 Nov 2006Complete
Phase II123.30 km864 Jun 2008 to 27 Aug 2011Complete
Phase III162.375 km111From 2011 to 18 Sep 2021Complete
Phase IVabout 110 km (DMRC annual report) or 112.4 km (Wikipedia)84 (Wikipedia)Construction began 30 Dec 2019Part open: about 24.25 km opened by Mar 2026
Phase V(A)16.076 km, three corridors13 (10 underground, 3 elevated), per the Cabinet noteCabinet approval 24 Dec 2025Approved, not open
Phase V(B)97.158 km, seven corridors (proposed)65Delhi approval 3 May 2026Awaiting Union approval
Bar chart of Delhi Metro phases: Phase I 64.75 km, Phase II 123.3 km, Phase III 162.375 km and Phase IV 112.4 km planned, of which about 24.25 km has opened.
Chart: length of Delhi Metro Phases I to IV in kilometres. Chart by AiTimeline from Wikipedia and Indian Infrastructure.

How the Delhi Metro Changed the Capital

What the evidence in the sources supports.

Reach across the region. The combined network serves Delhi and neighbouring cities, with 303 stations and 31 interchange stations reported in August 2026. The core network is only part of that: the Aqua Line connects Noida and Greater Noida and the Rapid Metro serves Gurugram.

Daily use. About 2.35 billion journeys in 2025 and roughly 64 lakh a day show that the system is now part of ordinary travel. AiTimeline did not find an independent study in the sources reviewed that measures how many car or two-wheeler trips it has replaced, so claims about congestion or emissions benefits should be read as plausible, not measured. The October 2024 report that Line 4 earned a carbon-neutral certification did not name the standard.

Pressure points. The record day showed crowded platforms on the Yellow, Blue and Violet lines. A longer network helps most when interchanges, station access and the final stretch of a journey work well, which is why Phase IV’s stated aim is interconnectivity between existing sections.

Phase IV remainder. The Golden Line (Aerocity to Tughlakabad, about 23.6 km) and the rest of the Magenta Line extension towards R.K. Ashram Marg are under construction, and no opening date was found. A December 2026 target appears for the priority corridors as a group (IANS, 24 Dec 2025). The three additional corridors (Rithala to Narela and Kundli, Lajpat Nagar to Saket G Block and Inderlok to Indraprastha) were approved but not open as of the last list reviewed (Metro Rail Guy).

Phase V(A). Approved by the Cabinet on 24 December 2025: R.K. Ashram Marg to Indraprastha with a Central Vista link, Aerocity to Terminal 1, and Tughlakabad to Kalindi Kunj. The Union Cabinet figure is ₹12,014.91 crore. A report said foundation stones were due on 8 March 2026 (AIR).

Phase V(B). Seven proposed corridors of 97.158 km and 65 stations, approved by the Delhi Government on 3 May 2026 and awaiting Union approval. For the larger picture of how India builds rail and road infrastructure, see AiTimeline’s Indian Railways electrification timeline and the Earth Day pledges review.

What Is Settled and What Is Not, as of 25 October 2026

Kept apart from the timeline because announcements and openings are different evidence.

QuestionPosition of the sourcesStatus
How long is the core Delhi Metro?374.47 km and 271 stations after 8 Mar 2026; a figure with Aqua Line and Rapid Metro is a different numberSettled; scope labelled
How long is the combined DMRC-operated network?416.5 km and 303 stations in an Aug 2026 PTI report quoting DMRCSettled
Is Phase IV complete?No. About 24.25 km has opened; the Golden Line and the rest of the Magenta extension are still under constructionPart open
When does the Golden Line open?No opening date was found. A Dec 2026 target appears for the priority corridors as a groupUnresolved
Is Phase V(A) built?Cabinet-approved on 24 Dec 2025 and foundation stones were scheduled for 8 Mar 2026; the corridors are not openApproved only
Is 99.95% punctuality independently verified?It is DMRC’s reported figure with a 59-second late threshold; no independent audit was foundOperator-reported
Is the 8.19 million record still standing?DMRC’s annual report and a 2026 PTI report both treat 8 Aug 2025 as the recordStanding, as far as found

Figure, Release or Report?

The same story sorted by who said it and how strong it is.

Figure or statementSourceTypeCaution
416.5 km, 303 stations, 12 lines; 99.95% punctuality; 64.06 lakh average dayPTI via Tribune, 9 Aug 2026News agency quoting DMRCOperator figures
394.25 km, 289 stations incl. Aqua Line and Rapid Metro; 8.19 million journeys on 8 Aug 2025DMRC Annual Report 2024-25Operator reportPre-March 2026 length
374.47 km, 271 stations (core)Wikipedia, List of Delhi Metro stationsReference compilationDated by the 8 Mar 2026 openings; not an official DMRC page
Two Phase IV sections opened on 8 Mar 2026Indian Infrastructure; All India RadioNews reportsStation counts differ between reports (eight or ten)
Phase V(A): 16.076 km, ₹12,014.91 croreIANS, 24 Dec 2025News agencyCabinet approval, not an opening
Phase V(B): 97.158 km, 65 stations, ₹48,204 croreWikipedia, citing the Delhi GovernmentReference compilationProposal awaiting Union approval
8.3 km opening stretch; inaugurated 24 Dec 2002Tribune, 25 Dec 2002Contemporary newspaperOther reports say 8.2 or 8.4 km
TS#01: four, six then eight coaches; 2.9 million km; 60 million passengersDMRC release, 24 Dec 2025Operator releaseRelayed in source material; not independently checked
Line 4 carbon neutralTribune, 14 Oct 2024News reportCertifier and standard not named

The Story at a Glance

Oldest first.

DateEventType
1969– 1984From a traffic study to a mass-transit proposalOrigins
3 May 1995DMRC is set upOrigins
1 Oct 1998Construction of Phase I beginsOrigins
24–25 Dec 2002Delhi Metro opens: Shahdara to Tis HazariOrigins
2006Phase I is finished: 64.75 km, 59 stationsNetwork
Oct 2010The Commonwealth Games deadline, and what was not readyNetwork
Aug 2011Phase II is completed: 123.30 km, 86 stationsNetwork
25 Dec 2017The Magenta Line opens Kalkaji Mandir to Botanical GardenNetwork
18 Sep 2021Phase III is completedNetwork
17 Sep 2023Airport Express extends to Yashobhoomi Dwarka Sector 25Network
5 Jan 2025Phase IV opens its first section: Janakpuri West to Krishna Park ExtensionNetwork
14 Oct 2024Line 4 reported carbon neutralService
8 Aug 2025Record day: 81,87,674 passenger journeysService
2025About 2.35 billion journeys in a yearService
24 Dec 2025The first train, TS#01, marks 23 yearsOrigins
24 Dec 2025Cabinet approves Phase V(A): three corridors, 16.076 kmPlanned
8 Mar 2026Two Phase IV sections open, taking the core network to 374.47 kmNetwork
3 May 2026Delhi approves Phase V(B): seven more corridors proposedPlanned
9 Aug 2026DMRC reports 99.95% punctuality and a 416.5 km networkService
TermMeaningWhy it matters here
Core networkDelhi Metro lines operated as DMRC’s own, excluding Aqua Line and Rapid MetroThe 374.47 km figure
Combined networkCore plus Noida Aqua Line plus Gurugram Rapid Metro, operated by DMRCThe 416.5 km figure
Passenger journeyOne completed trip, counted each timeNot a count of different people
Interchange stationA station where two or more lines meetCounted once per line in headline station totals
HeadwayTime between trainsPTI reports 2 min 18 sec on busy corridors
UTOUnattended train operation, driverless runningAbout 29% of the network, per PTI
PhaseA government-approved block of corridorsApproval, construction and opening are separate steps

Who Is Who

Operator

DMRC

Delhi Metro Rail Corporation, set up on 3 May 1995 as a joint venture of the Government of India and the Government of Delhi. Also operates the Aqua Line and Rapid Metro.

Leadership

E. Sreedharan

DMRC’s managing director when it was set up in 1995, per Wikipedia.

2002 launch

Atal Bihari Vajpayee

Prime Minister who inaugurated the first section on 24 Dec 2002 and rode from Kashmere Gate to Seelampur.

Finance

Japan (JBIC)

Financed 56% of the first phase through a soft loan of up to ₹2,090 crore, per the Tribune in 2002.

Connected systems

Aqua Line and Rapid Metro

The Noida-Greater Noida Aqua Line and Gurugram’s Rapid Metro, counted only in the combined 416.5 km.

Approvals

Union Cabinet

Approved Phase V(A) on 24 Dec 2025; Phase V(B) still awaits Union approval.

The Popular Story vs the Record

Popular versionWhat the record shows
Delhi Metro is 352 km, or 394 km, or 416 km longAll three were right for their own scope and date: 352-353 km core before March 2026, 394.25 km combined before March 2026, 416.5 km combined after. The core network is now 374.47 km
The Pink Line opened on 25 Dec 2017The Magenta Line section Kalkaji Mandir to Botanical Garden opened on 25 Dec 2017. The first listed Pink Line section opened on 14 Mar 2018
The Airport Express opened for the 2010 Commonwealth GamesIt opened on 23 Feb 2011, after the Games, and reached Aerocity on 15 Aug 2011
Delhi Metro started on 25 Dec 2002It was inaugurated on 24 Dec 2002 and opened to the public on 25 Dec
8.19 million people rode on the record dayDMRC counts passenger journeys. Someone travelling both ways is two journeys
99.9% punctuality means trains are almost never lateIt is DMRC’s own measure, with a train late only after 59 seconds, and still allows delays on individual journeys
Phase V is already being builtV(A) is Cabinet-approved and had foundation stones scheduled; V(B) is a state-approved proposal
Advertisement

Explore More Timelines

People Also Ask

How long is Delhi Metro in km?
As of October 2026, about 374.47 km for the core Delhi Metro network, or about 416.5 km including the Noida Aqua Line and Gurugram Rapid Metro, according to Wikipedia and a PTI report quoting DMRC.
Is Delhi Metro the busiest metro in India?
AiTimeline did not compare against other Indian systems for this page. Delhi Metro reported about 2.35 billion journeys in 2025 and a record 8.19 million journeys on 8 August 2025.
When did Delhi Metro open to the public?
On 25 December 2002, one day after its 24 December inauguration by Prime Minister Vajpayee.
What will Delhi Metro look like after Phase IV?
Phase IV adds about 112 km across six corridors. Only part of it is open, and the full extent depends on sections still under construction or approved.
Who built the Delhi Metro?
The Delhi Metro Rail Corporation, with E. Sreedharan as managing director, built it with Japanese loan financing for the first phase.

Frequently Asked Questions

How long is the Delhi Metro network in 2026?
It depends on what is counted. As of October 2026 the core Delhi Metro network is 374.47 km with 271 stations on 10 lines (Wikipedia, after the 8 March 2026 openings). Including the Noida Aqua Line and Gurugram Rapid Metro, which DMRC also operates, PTI reported 416.5 km and 303 stations on 12 lines in August 2026.
Why do sources give 352 km, 374 km, 394 km and 416 km?
They differ in date and scope. About 352-353 km was the core network before 8 March 2026, and 374.47 km is the core network after it. DMRC’s 2024-25 annual report gave 394.25 km and 289 stations for the core plus Aqua Line and Rapid Metro, and 416.5 km is the same combined scope after the March 2026 openings.
Does the 416.5 km figure include the Aqua Line and Rapid Metro?
Yes. DMRC operates the Noida-Greater Noida Aqua Line (about 29.7 km, 21 stations) and Gurugram Rapid Metro, and the 416.49 km, 303-station figure adds them to the 374.47 km, 271-station core network.
When did Delhi Metro start?
The Prime Minister inaugurated it on 24 December 2002, and public service on the Shahdara to Tis Hazari section on the Red Line began on 25 December 2002. The opening stretch was about 8.3 km according to the Tribune; other reports say 8.2 or 8.4 km.
Who runs the Delhi Metro?
The Delhi Metro Rail Corporation (DMRC), set up on 3 May 1995 as a joint venture of the Government of India and the Government of Delhi. DMRC also operates the Noida Aqua Line and Gurugram Rapid Metro.
When did Delhi Metro construction begin?
Construction of Phase I began on 1 October 1998, after the DMRC was set up in 1995 and Japan had granted official development assistance loans in 1997 to finance the first phase.
How many people use Delhi Metro?
Wikipedia, citing DMRC data, gives about 2.35 billion passenger journeys and roughly 64.6 lakh a day in 2025. PTI reported an average of about 64.06 lakh a day in 2026. These count journeys, not unique people.
What is the Delhi Metro ridership record?
81,87,674 passenger journeys (about 8.19 million) on 8 August 2025, the eve of Raksha Bandhan, according to DMRC via IANS. A 2026 PTI report still describes that as the record.
Is the Delhi Metro really 99.9% punctual?
DMRC reported 99.95% punctuality for 2026 so far, in an August 2026 PTI report, with a train counted as late if it is more than 59 seconds behind schedule. It is an operator-reported figure, not an independent audit.
What was Delhi Metro punctuality in earlier years?
PTI reported 98.27% in 2003 and 99.64% in 2005, with performance near 99.9% since. Definitions and measurement periods matter when comparing with other operators.
How long did each phase of Delhi Metro take?
Phase I ran from 2002 to 2006 (64.75 km, 59 stations), Phase II from 2008 to 2011 (123.30 km, 86 stations) and Phase III from 2011 to 2021 (162.375 km, 111 stations). Phase IV began construction on 30 December 2019 and is still being completed.
What is Delhi Metro Phase IV?
A programme of six corridors: DMRC’s 2024-25 annual report says about 110 km, and Wikipedia lists 112.4 km and 84 stations. It includes Janakpuri West to R.K. Ashram Marg, Tughlakabad to Aerocity and Majlis Park to Maujpur. Several sections have opened, and others are still under construction or approved.
Which Phase IV sections have opened?
Janakpuri West to Krishna Park Extension (2.03 km, 5 January 2025), Deepali Chowk to Majlis Park (9.92 km) and Majlis Park to Maujpur Babarpur (12.3 km), the last two on 8 March 2026.
When will the Golden Line open?
No opening date was found in the sources reviewed. The Aerocity to Tughlakabad Golden Line (about 23.6 km) is a Phase IV priority corridor under construction, and a December 2026 target applies to the priority corridors as a group in a December 2025 IANS report.
What is Delhi Metro Phase V(A)?
Three corridors of 16.076 km at a stated cost of 12,014.91 crore rupees, approved by the Union Cabinet on 24 December 2025: R.K. Ashram Marg to Indraprastha, Aerocity to IGI Airport Terminal 1, and Tughlakabad to Kalindi Kunj.
What is Phase V(B)?
According to Wikipedia, on 3 May 2026 the Government of Delhi approved seven corridors totalling 97.158 km with 65 stations at about 48,204 crore rupees and sent the proposal to the Union Government. It is not yet a Union-approved project.
How big is the planned expansion?
A July 2026 Business Today feature put Phases IV, V(A) and V(B) together at about 217 km, 123 stations and 16 corridors. That is a plan, and it mixes under-construction, approved and proposed sections.
Does Delhi Metro go to the airport?
Yes. The Airport Express runs from New Delhi to IGI Airport and on to Yashobhoomi Dwarka Sector 25, extended on 17 September 2023. Phase V(A) approved a link to Terminal 1 from Aerocity.
When did the Airport Express open?
The first section, New Delhi to Dwarka Sector 21, opened on 23 February 2011, after the October 2010 Commonwealth Games. The Dhaula Kuan and Delhi Aerocity extension followed on 15 August 2011.
What opened on 25 December 2017?
The Magenta Line section from Kalkaji Mandir to Botanical Garden, part of Phase III. It was not a Pink Line section: the Pink Line’s first listed section opened on 14 March 2018.
What is TS#01?
DMRC’s original train from 2002. DMRC says it began with four coaches, went to six in 2014 and eight in 2023, and is still in service. AiTimeline could not open DMRC’s release, so treat these figures as DMRC-reported.
Which lines are driverless?
The Pink Line began driverless operation on 25 November 2021 and the Magenta Line on 28 December 2021. PTI says about 29% of the network now runs with unattended train operation.
What is the Delhi Metro minimum headway?
PTI reported a minimum headway of 2 minutes 18 seconds on busy corridors, down from 7 minutes at the start. It is the shortest interval, not the typical wait on every line.
How was Delhi Metro funded?
Japan financed 56% of the first phase through a soft loan of up to 2,090 crore rupees, according to the Tribune in December 2002. Later phases have combined central, Delhi and international funding.
Is the Delhi Metro good for the environment?
Rail transit can cut road emissions if it replaces car and two-wheeler trips, but the net effect depends on electricity sources and ridership. The Tribune reported in October 2024 that Line 4 got a carbon-neutral certification, without naming the standard.
How many interchange stations does the network have?
PTI reported 31 interchange stations in August 2026. Wikipedia counts 271 stations on the core network with interchanges counted more than once, and 243 if each is counted once.
Why do station counts differ?
Interchange stations appear on more than one line. Wikipedia’s 271 counts them each time; counted once, the core network has 243 stations. The 303 figure adds Aqua Line and Rapid Metro stations to 271.
Which source is best for the network length?
DMRC’s own current map or press release, with its date. AiTimeline could not open DMRC’s website pages directly, so this page cites Wikipedia for the core figure and a PTI report quoting DMRC for the combined figure.
What does ‘passenger journeys’ mean?
Each completed trip counts once, so one person travelling to work and back is two journeys. It is not a count of unique riders.
Is the Delhi Metro free of delays?
No. Punctuality is a measure of trains arriving within a set threshold. Equipment failures, crowding, security incidents and weather can still delay individual journeys.
What should I check before quoting a Delhi Metro length?
Say whether it is the core network or includes the Aqua Line and Rapid Metro, give the date, and say whether it counts only open sections. A target date or approval is not an opening.

More Than a Metro Network

The Delhi Metro grew from an 8-km opening stretch in 2002 into a 374.47 km core network and a 416.5 km combined system serving Delhi and its neighbours. Its reputation for punctuality rests on operator-reported figures that look strong, and its ridership record shows demand that keeps growing. The next test is not only adding kilometres but finishing Phase IV, turning approved corridors into running lines and keeping reliability as crowds grow.

Related AiTimeline Stories

⚠️ Editorial Note

Last updated 25 October 2026. Network length depends on scope: the core Delhi Metro (374.47 km, 271 stations) excludes the Noida Aqua Line and Gurugram Rapid Metro, while the combined figure (416.5 km, 303 stations) includes them. Punctuality and ridership are operator-reported. Approved or proposed corridors are not sections open to passengers. DMRC’s own network and corporate pages could not be read by AiTimeline, so the core length rests on Wikipedia and PTI; the Phase V(A) approval page on the PM’s site was blocked and IANS was used instead. The source brief’s earlier 352.2 km and 394.3 km figures were correct for their date but out of date after 8 March 2026; its “Pink Line” label for 25 December 2017 was corrected to Magenta Line. No photographs are used because their licences could not be verified.

Advertisement
West Africa’s Gold Refineries: A Timeline of Economic Sovereignty and Value Addition Vikas Dubey Encounter Timeline: Bikru Ambush, Police Inquiry and Supreme Court Review
→
Next Article
